TL;DR
SAP HANA migration means moving SAP systems onto the SAP HANA database, or moving an existing HANA system to new hardware, a new version, or the cloud. The right method depends on where you start. Systems on Oracle, SQL Server, DB2, or MaxDB usually move with the Database Migration Option of SUM or a classical export and import. By contrast, systems already on HANA usually move with backup and restore or HANA System Replication. Most delays come from untested downtime estimates and from the reports, pipelines, and interfaces that sit around the database. Plan those pieces as carefully as the database move itself, and rehearse the cutover at least twice.
Key Takeaways SAP HANA migration covers five scenarios, from anyDB to HANA through HANA 1.0 to 2.0 and moves to SAP HANA Cloud. DMO of SUM can combine the software update, Unicode conversion, and database move in one run for eligible systems. By comparison, HANA-to-HANA moves are simpler and usually rely on backup and restore or HANA System Replication. Downtime estimates only become reliable after full-volume mock runs on production-sized data. Reports, ETL pipelines, and interfaces around HANA cause more late surprises than the database itself. Automation accelerators like FLIP cut the manual effort in discovery, conversion, and validation around the move. A Cutover Weekend Starts Months Earlier Picture the Friday night of a planned HANA cutover. The export has been running for six hours, and it is already two hours behind the plan written in the project charter.
Watch on YouTube
What Do Companies Miss Before Starting a Data Migration?
Kanerika’s migration team walks through the gaps that surface late in migration programs and how to catch them during assessment.
Nobody made an error during the weekend itself. That is because the downtime estimate came from a test system a tenth the size of production, and the three largest tables were never profiled.
That gap between the plan and the real system is where most SAP HANA migration projects get hurt, and it mirrors the pattern in broader data migration programs. The pressure is real too, because SAP ends mainstream maintenance for SAP Business Suite 7 core applications at the end of 2027, so many teams now face a fixed date and a database decision at the same time.
What Is SAP HANA Migration? SAP HANA migration is the process of moving an SAP system onto the SAP HANA in-memory database, or relocating an existing HANA database to new infrastructure, a newer release, or a cloud service. It covers the database, the application servers that talk to it, and every system that reads from it.
The term gets used loosely. Some teams mean a pure database platform change, some mean a full S/4HANA conversion, and some mean moving HANA from an on-premises appliance to a hyperscaler.
SAP HANA Database Migration vs SAP S/4HANA Migration A HANA database migration changes the platform under an SAP application. An ECC system can move from Oracle to HANA and still run ECC afterward, with the same business processes and the same custom code.
An S/4HANA migration changes the application itself, and it requires HANA because S/4HANA runs only on the SAP HANA database. The data work behind that change, including Business Partner conversion and master data cleansing, is covered in our SAP data migration guide .
Many enterprises do both in sequence. They move the database first to reduce risk, then convert to S/4HANA once the platform is stable.
Why Enterprises Move to SAP HANA The first reason is the roadmap. SAP’s maintenance strategy page confirms mainstream maintenance for Business Suite 7 core applications until the end of 2027, with optional extended maintenance until the end of 2030.
The second reason is performance. Columnar in-memory storage speeds up reporting and analytical queries that used to run as overnight batch jobs, and it opens the door to AI in ERP use cases.
The third reason is simplification. In addition, fewer aggregate tables and fewer database vendors mean fewer licenses, fewer skill sets, and fewer places for data to drift out of sync.

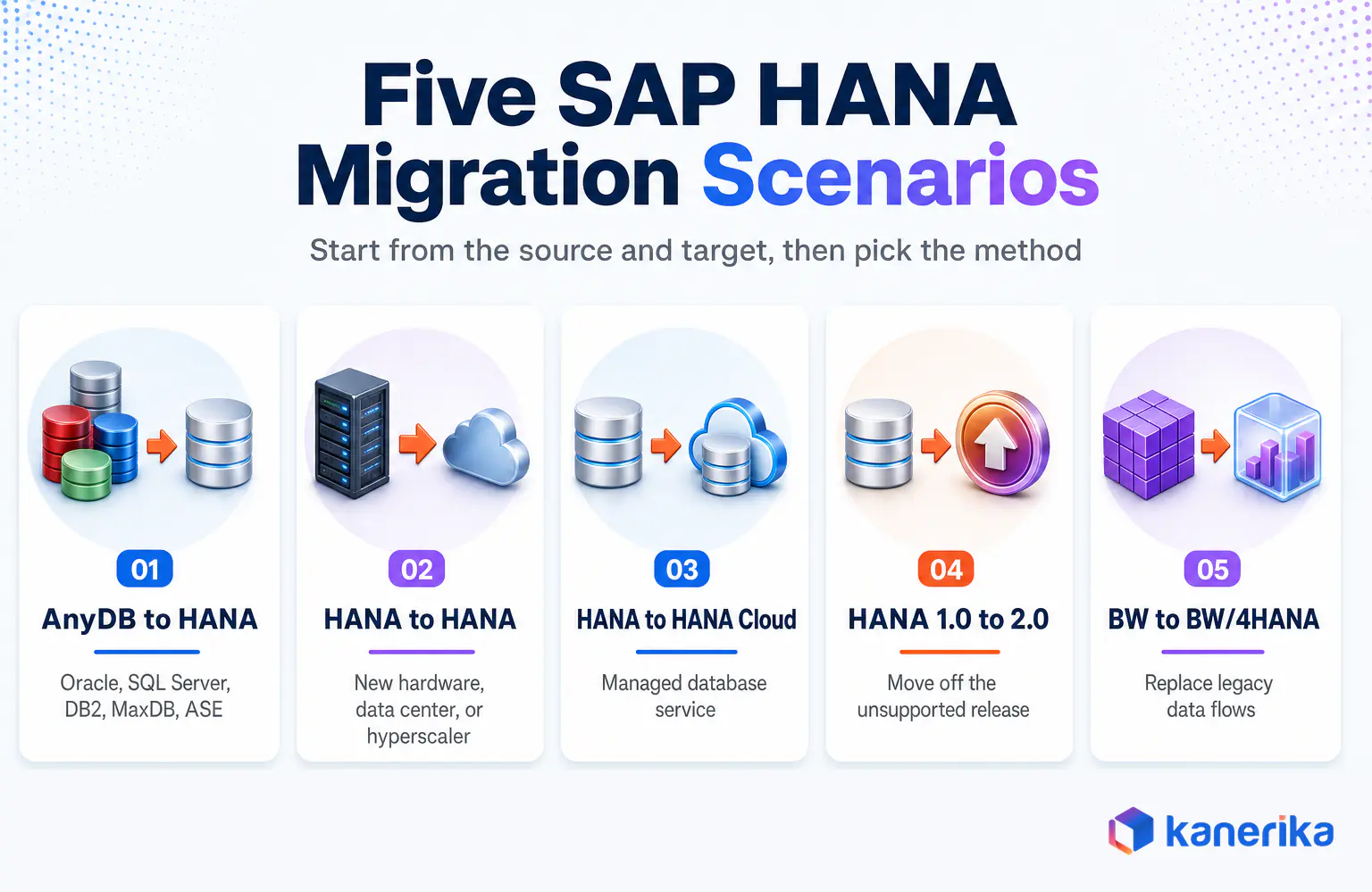

Five SAP HANA Migration Scenarios and When Each Applies Every HANA project starts with one question. What is the source, and what is the target? The answer decides the tools, the downtime profile, and the size of the testing effort.
1. AnyDB to SAP HANA This is the classic heterogeneous move from Oracle, Microsoft SQL Server, IBM DB2, SAP MaxDB, or SAP ASE to HANA. It is the most involved scenario because the database vendor, the data types, and often the operating system all change at once.
Custom ABAP code also needs checks here. Code written for a row-based database can behave differently on HANA, especially code that relies on implicit sort order.
2. SAP HANA to SAP HANA This homogeneous move shifts HANA to new hardware, a new data center, or a hyperscaler such as AWS, Azure , or Google Cloud. The database engine stays the same, so the work centers on infrastructure, sizing, and cutover logistics.
AWS documentation for HANA-to-HANA moves lists backup and restore, classical migration, and HANA System Replication as the main options. The same options apply on the other major clouds.
3. SAP HANA to SAP HANA Cloud Because SAP HANA Cloud is a managed database service, this move changes the operating model as well as the location. For the move itself, SAP offers self-service migration tools that estimate required capacity and move catalog objects, schemas, and data.
Feature parity needs checking before you commit. Some on-premises features and XS classic applications need redesign rather than a straight move.
4. SAP HANA 1.0 to SAP HANA 2.0 Maintenance for the last HANA 1.0 release ended in June 2021, according to an SAP Community notice . Any system still on 1.0 is running unsupported, and many integrations have already stopped supporting 1.0 connections.
Overall, the upgrade is usually the smallest scenario on this list. It still needs regression testing, because query plans and default settings change between releases.
5. SAP BW to BW/4HANA BW systems follow their own path. A BW on anyDB system usually moves to BW on HANA first, and then converts to BW/4HANA, which requires legacy data flows and objects to be replaced with HANA-optimized equivalents.
BW is also where downstream reporting breaks most often. Queries, BusinessObjects universes, and extracts all point at BW objects that change during the conversion.
SAP HANA Migration Methods Compared Once the scenario is clear, the method follows. Each option trades speed, downtime, and complexity differently, so base the choice on your downtime window and database size.
Table 1: SAP HANA migration methods by scenario and downtime profile
Method Best fit How it works Downtime profile Watch out for DMO of SUM AnyDB to HANA with an update or S/4HANA conversion Combines software update, optional Unicode conversion, and database move in one tool run Medium, lower with downtime-optimized options Version prerequisites and long runtimes on very large tables Classical migration Heterogeneous moves with no update needed Export from source and import into HANA with Software Provisioning Manager Medium to high Export and import tuning, table splitting, file transfer time Backup and restore HANA to HANA with a generous window Full backup shipped to target, then restored Grows with database size and network speed Transfer time for multi-terabyte backups HANA System Replication HANA to HANA with a tight window Target stays in sync, then takes over at cutover Low, often minutes to a few hours Version compatibility and replication network bandwidth SAP HANA Cloud self-service tools On-premises HANA to HANA Cloud Guided capacity estimate, then object and data migration Depends on data volume and redesign needs Unsupported features that need redesign
How DMO Changes the Math The SAP Community introduction to DMO describes it as a single tool that combines the SAP upgrade with the database migration to HANA. Unicode conversion can run in the same step when the target is based on release 7.40.
The source database stays consistent during DMO, which makes fallback faster if the run fails. For many teams that fallback path is the deciding factor, because it limits the damage of a bad weekend.
When Classical Migration Still Wins Classical export and import still makes sense when no software update is planned or when DMO prerequisites cannot be met in time. It also gives Basis teams fine control over table splitting and parallel export jobs.
The cost is more steps and more handoffs. Each extra step is another place for the runbook to drift from reality.
Kanerika Service
Data Migration Services
Kanerika plans and runs migrations with automated discovery, conversion, and validation, so programs finish on schedule with numbers the business trusts.
Explore Migration Services SAP HANA Migration Tools and What Each One Does The tool list is short, but each tool has a narrow job. Mixing them up, though, leads to runbooks that look complete on paper and fail on the night.
Software Update Manager (SUM) runs updates and upgrades, and also hosts DMO for combined update and database moves.Software Provisioning Manager (SWPM) handles system copies, such as heterogeneous export and import.HANA backup and recovery moves HANA-to-HANA systems when the downtime window allows a full restore.HANA System Replication keeps a target in sync so cutover becomes a fast takeover.SAP HANA Cloud self-service migration estimates capacity and then moves objects and data into the managed service.Sizing reports and SAP Quick Sizer estimate memory and CPU needs for the target before hardware is ordered.However, none of these tools touch the reports, pipelines, or interfaces that read from the database. Broader data migration tools fill some of that gap. That gap is covered later in this guide, because it is where most schedules slip.
Choosing a Target Platform for SAP HANA Where HANA runs after the move shapes cost, control, and operations for years. Most enterprises choose between four options.
On-premises appliance or TDI gives full control and uses existing data center investment, although hardware refresh cycles still need managing.Hyperscaler IaaS runs HANA on SAP-certified AWS, Azure, or Google Cloud instances, while your team or a partner runs Basis.RISE with SAP is a bundled subscription where SAP takes on more of the infrastructure and technical operations.SAP HANA Cloud is a managed database service suited to new development and analytics workloads rather than every ERP scenario.The right choice depends on how much operational control you want to keep and where the rest of your data platform lives. Enterprises running analytics on Microsoft Fabric or Databricks often pick the same cloud for HANA to keep data transfer short and costs predictable.
Make this decision before sizing. Instance families, storage types, and replication options differ by platform, and each one changes the migration method that fits best.
Prerequisites to Clear Before You Start Most failed cutovers trace back to a prerequisite that was assumed rather than checked. Clear these early, while fixes are still cheap.
Release and Unicode Readiness Confirm the SAP release, kernel, and support package levels that your chosen method requires. Non-Unicode systems need a conversion plan, either inside DMO for eligible targets or as a separate project step.
Sizing Memory, CPU, and Storage HANA holds data in memory, so sizing errors are expensive in both directions. Undersizing hurts performance on day one, while oversizing locks in hardware or cloud costs for years.
Archive and clean data before sizing. Old change documents, logs, and closed transactions often inflate the footprint and the migration runtime.
Custom Code and Add-Ons Run code checks for HANA compatibility and review every third-party add-on against the target release. Add-on vendors often need their own certification step, and their timelines are also outside your control.
Infrastructure and Network Use SAP-certified hardware or a supported cloud instance type. Test network throughput between source and target, because transfer speed often sets the real limit on downtime.

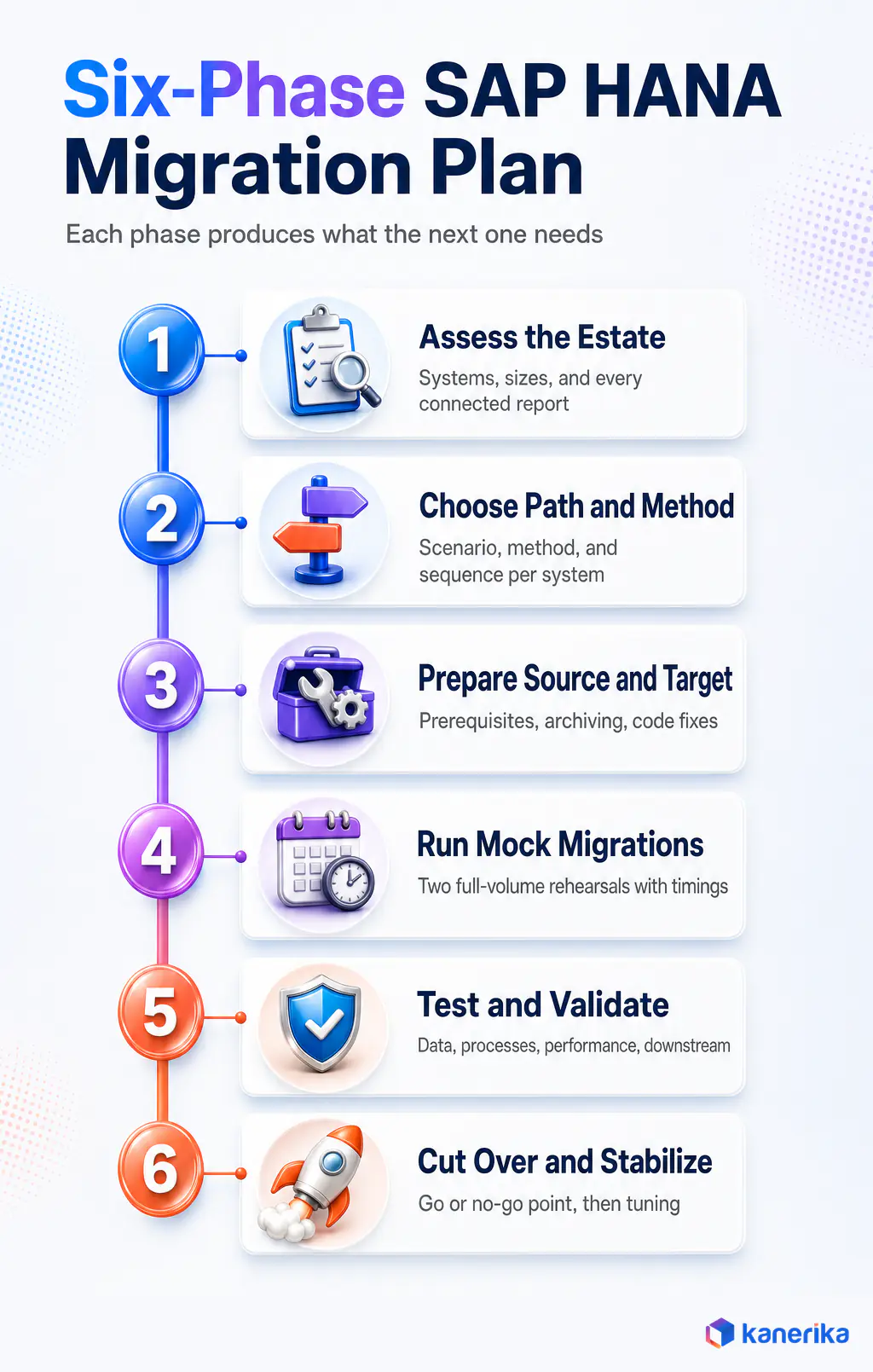

Step-by-Step SAP HANA Migration Plan A plan that holds has six phases, and each one produces something the next phase depends on. So skipping ahead to execution is the most common way to lose a weekend.
Phase 1. Assess the SAP Estate Inventory every SAP system, its database, its size, and its growth rate. Tracing data lineage early shows which downstream systems each table feeds. List every connected report, interface, extract, and downstream platform, because each one needs a test case later.
Phase 2. Choose the Path and Method Match each system to a scenario and a method from Table 1, and fold the result into a wider cloud migration roadmap where cloud is in scope. Decide whether the database move and any S/4HANA conversion run together or in sequence.
Phase 3. Prepare Source and Target Provision the target, apply prerequisites, archive old data, and fix code findings. Freeze nonessential transports so the system you test is the system you move.
Phase 4. Run Mock Migrations Run at least two full-volume rehearsals on a copy of production. The data migration checklist covers what each rehearsal should prove. Record the real runtime of every step, and rewrite the runbook with those numbers.
Phase 5. Test and Validate Test technical health, business processes, data counts, performance, and every downstream consumer. Treat a report that shows different numbers as a failed test, even if the database is healthy.
Phase 6. Cut Over and Stabilize Execute the rehearsed runbook, validate with business owners, and hold a defined go or no-go point. Monitor performance closely for the first weeks, and tune the heaviest queries first. Each phase maps to the wider data migration life cycle .
How to Keep SAP HANA Migration Downtime Under Control Downtime is the number the business remembers. It shrinks when you reduce the data that moves during the window and when you replace guesses with measured runtimes.
Archive before you move , since every gigabyte left behind is time saved on export, transfer, and import.Use replication for HANA-to-HANA moves , because HANA System Replication turns cutover into a takeover measured in minutes to hours.Consider downtime-optimized DMO , which moves part of the data while the system is still running, for eligible scenarios.Tune parallelism and table splitting , since large tables processed as one unit set the floor for the whole run.Measure, then commit , and only publish a downtime window after two full-volume mock runs agree.Listen on Spotify
Types of Data Migration Every Enterprise Must Know in 2026
Testing and Validation That Catches Problems Early A healthy database does not mean a healthy migration. Validation has to prove that the business sees the same numbers after the move as before it.
Table 2: SAP HANA migration validation layers
Layer What to check Owner Technical Database consistency, system logs, backups, job scheduling SAP Basis Data Row counts, totals, and key financial balances matched source to target Data team and finance Functional Order to cash, procure to pay, month-end close, batch jobs Business process owners Performance Top transactions and reports against a pre-migration baseline Basis and application teams Downstream BI reports, ETL pipelines, extracts, APIs, and interfaces Analytics and integration teams
The downstream row is the one most test plans cover thinly. The data migration testing guide explains how to build reconciliation checks that run automatically instead of by hand, and the roundup of data reconciliation tools compares options.

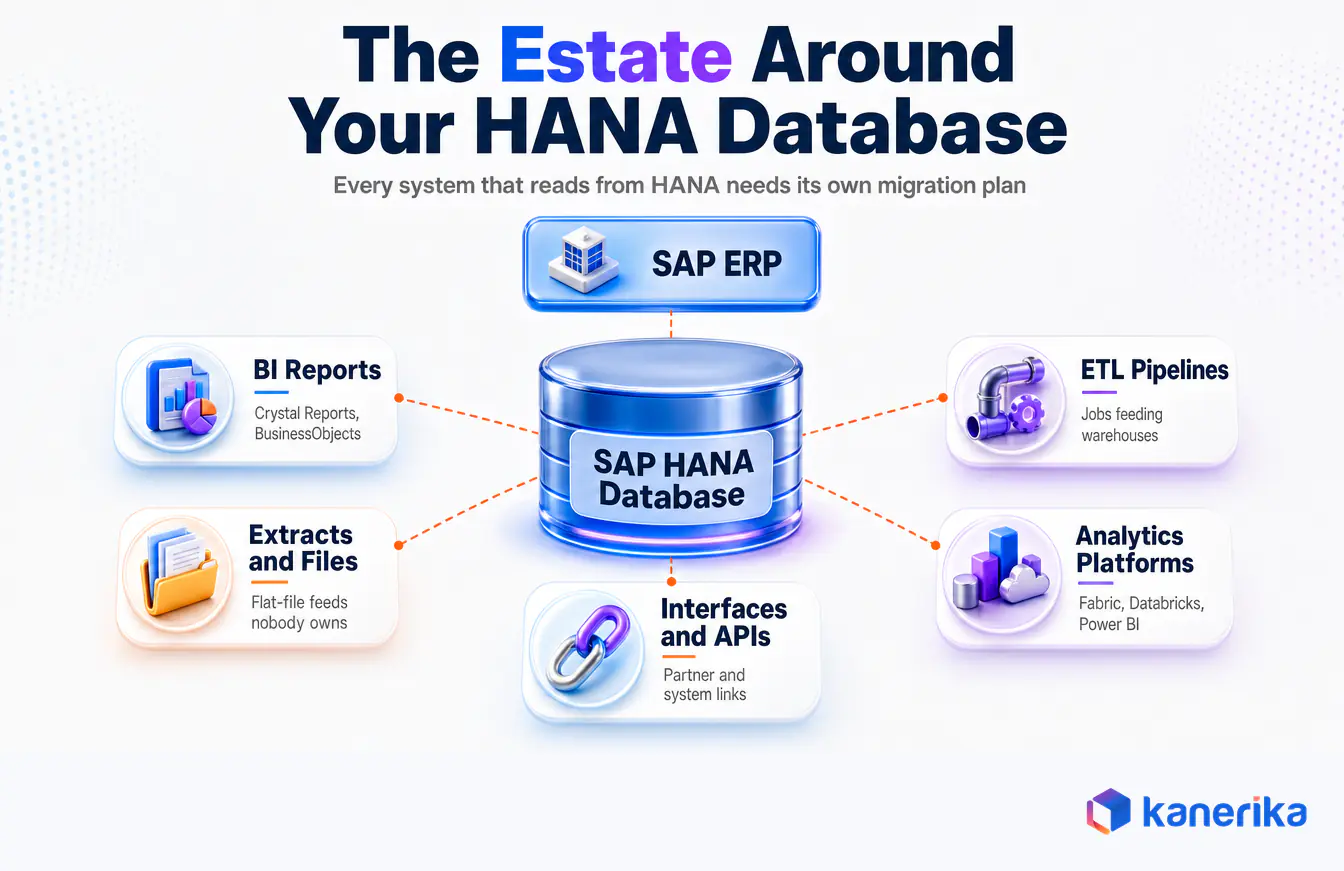

The Layer Most HANA Plans Forget SAP tools move the database well. They do not move or test the reporting and integration estate that grew around it over ten or twenty years.
That estate is large in most enterprises. It includes Crystal Reports and SAP BusinessObjects reports, SQL views, ETL jobs, flat-file extracts, and pipelines feeding data warehouses or Microsoft Fabric.
Each of these can break without warning when the database changes. A renamed table, a changed data type, or a new connection string leaves the SAP system running. Meanwhile, the finance report that depends on it fails on the first Monday after go-live.
Three Signs the Surrounding Estate Needs Its Own Workstream No one can produce a complete list of reports and pipelines that read from the SAP database. Business logic lives inside report formulas or ETL jobs rather than in SAP itself. The HANA project is also a moment to retire legacy BI tools or move analytics to a modern platform such as Power BI . If any of these apply, treat the surrounding estate as a parallel migration with its own inventory, conversion plan, and validation. The risks in data migration guide covers how hidden dependencies derail schedules.

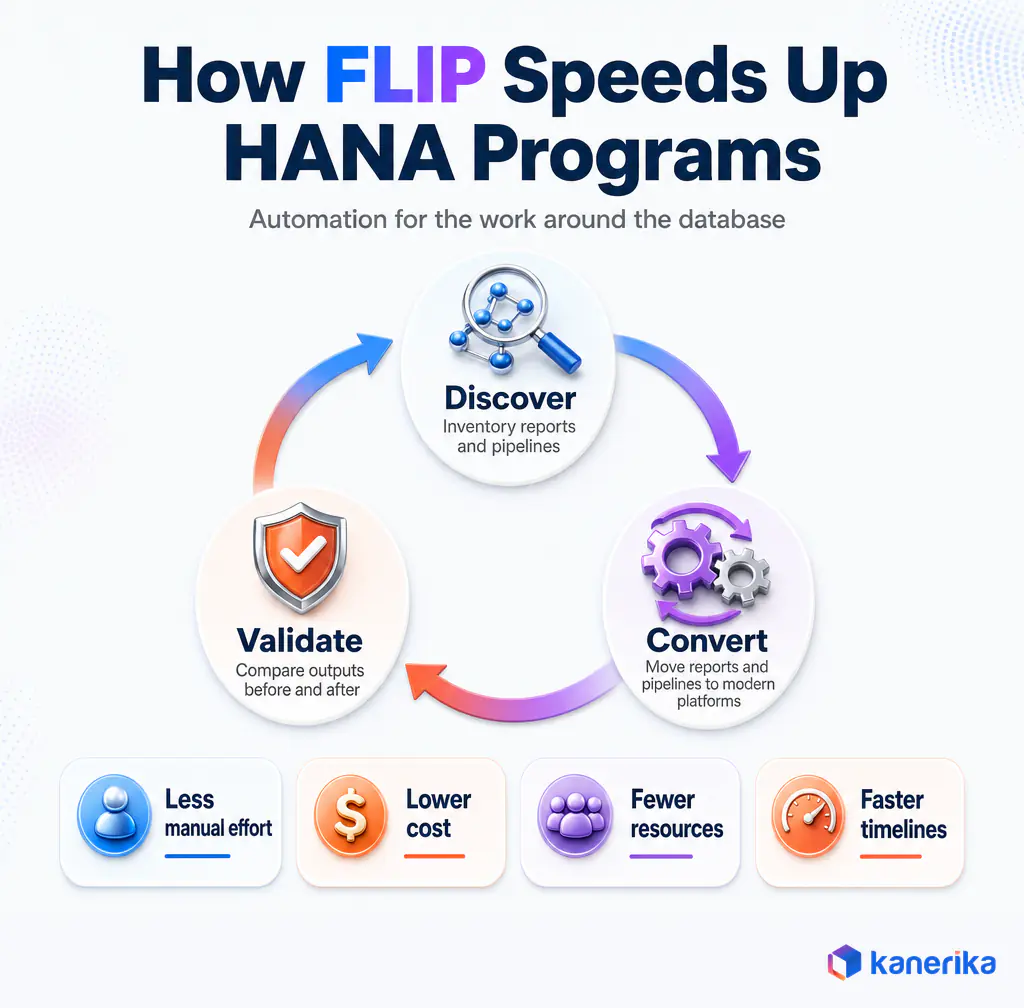

How FLIP Speeds Up the Work Around a HANA Migration FLIP is Kanerika’s AI-powered migration and workflow automation platform. In a HANA program, it takes on the slow, manual work that surrounds the database move, so teams spend less time on repetitive tasks and more time on decisions.
1. Automated Discovery FLIP scans the reporting and pipeline estate and builds an inventory of what exists, what depends on what, and what can be retired. As a result, teams start the project with a clear, evidence-based scope.
2. Automated Conversion When the HANA move is paired with analytics modernization, FLIP converts legacy reports and pipelines to modern targets. Paths include Crystal Reports to Power BI and ETL pipelines to Microsoft Fabric or Databricks, with business logic carried over automatically.
3. Automated Validation FLIP compares outputs before and after the move and flags mismatches. That removes much of the manual reconciliation that normally eats the last weeks of a project.
What That Means for the Program The practical result is less manual effort, lower migration cost, fewer people tied up in repetitive work, and less uncertainty about whether everything still works. FLIP is also available on the Microsoft Azure Marketplace .
SAP HANA Migration Costs and Timeline Drivers No honest guide can give one number for cost or duration. Both depend on a handful of drivers that you can measure early.
Database size after archiving drives runtime, hardware, and cloud spend.Scenario and method matter because a HANA-to-HANA replication move costs far less effort than an anyDB move with a release update.Custom code volume adds work, since more custom code means more checks, fixes, and regression tests.Surrounding estate effort can match the database move when there are hundreds of reports and interfaces.Downtime tolerance shapes cost, because tighter windows need more rehearsals and more specialized techniques.Licensing model choices, such as HANA licensing and the pick between on-premises, hyperscaler, and RISE with SAP, change the run cost.Automation lowers the cost of the drivers that scale with volume, especially discovery and validation. Use the migration ROI calculator to estimate the effect for your own estate.
Common SAP HANA Migration Challenges and How to Avoid Them The same few problems show up across projects. Most are avoidable with early measurement.
Sizing From Guesswork Teams size the target from current database size without archiving or growth modeling. Run sizing reports after cleanup and add realistic growth.
Downtime Estimated on Small Test Systems Runtimes do not scale in a straight line. Base the downtime window on full-volume mock runs only.
Untested Custom Code Code that assumed a sort order or a database-specific behavior breaks on HANA unless it is fixed first. Run code checks early and fix findings before the first mock run.
Forgotten Downstream Consumers Reports and interfaces fail after go-live because no one owned them. Inventory them in Phase 1 and give each one a test case.
Weak Rollback Planning A rollback plan that was never tested is a hope. Define the go or no-go point, the fallback steps, and the time needed to execute them.
SAP HANA Migration and the 2027 Deadline The end of 2027 mainstream maintenance date shapes most HANA roadmaps today. Enterprises generally pick one of three sequences.
Database first means moving ECC to HANA now, then converting to S/4HANA later on a stable platform.Combined conversion uses DMO to move the database and convert to S/4HANA in one program.New implementation builds S/4HANA fresh and migrates only selected data, which is covered in the SAP data migration tools comparison.Database first lowers risk per step but adds a second project. Combined conversion saves time but concentrates risk into one cutover, so it needs the strongest rehearsal discipline.
Extended maintenance to 2030 buys time at a price. Treat it as a buffer for execution and make the platform decision now, as part of a wider legacy system modernization plan.
How Kanerika Supports SAP HANA Migration Programs A HANA program succeeds when the database move and the data estate around it are planned together. That is where Kanerika focuses, as a Microsoft Solutions Partner for Data and AI with ISO 27001 and SOC 2 certified delivery.
Datasheet
FLIP Migration Accelerators
See how FLIP automates pre-migration discovery, conversion, and data validation to cut manual effort, cost, and delivery risk.
View the Datasheet → The Delivery Approach Assess by mapping the SAP systems, the reports, pipelines, and interfaces around it, and the dependencies between them, using data engineering and discovery automation.Design by picking the scenario and method per system and designing the target analytics platform, often a Microsoft Fabric architecture , where modernization is in scope.Migrate by running discovery, conversion, and validation with FLIP while the SAP Basis work runs in parallel.Govern by applying role-based access and data governance on the new platform from day one.Enable report owners through training, then hand over runbooks and monitoring.Case Study. 3 SAP Systems Unified on Microsoft Fabric A manufacturer ran its order journey across three disconnected SAP systems, with lead times tracked by hand and numbers that did not match across teams. The Kanerika team built one governed pipeline on Microsoft Fabric connecting all three systems and roughly 35 source tables.
The result was 60% less reporting effort , one view from lead to delivery, 50+ governed KPIs, and four-level row-level security aligned to region and sales structure.
What Kanerika Teams Watch For Experience across migrations points to the same pressure points. Reports that hold hidden business logic, extracts nobody owns, and reconciliation left to the final week are the usual causes of late surprises.
Starting discovery and automated validation early removes most of that risk. It also gives the business a measurable definition of done.
Talk to Kanerika
Planning a HANA Move Before 2027?
Talk to Kanerika’s migration team about scoping the database move and the reports, pipelines, and interfaces around it.
Book a Meeting → Wrapping Up SAP HANA migration is a set of scenarios, each with its own method, prerequisites, and downtime profile. Choosing the right method is only half the job.
The other half is the estate around the database. Reports, pipelines, and interfaces need the same inventory, conversion, and validation discipline as the database itself.
Rehearse on full-volume data, validate what the business sees, and use automation where volume makes manual work slow. With the 2027 date approaching, that discipline is what keeps a cutover weekend on plan.
Frequently Asked Questions
What is SAP HANA migration? SAP HANA migration is the move of an SAP system onto the SAP HANA in-memory database, or the move of an existing HANA database to new hardware, a newer release, or the cloud. It includes the database, the application servers, and every report, pipeline, and interface that reads from the system.
How long does an SAP HANA migration take? Most SAP HANA migrations take a few months from assessment to go-live, while the cutover itself usually fits inside a weekend. The duration depends on database size, the migration method, custom code volume, and the number of connected reports and interfaces. Full-volume mock runs give the only reliable estimate for your own system.
What is the difference between DMO and classical migration? DMO of SUM combines a software update, an optional Unicode conversion, and the database move to HANA in one tool run. Classical migration exports data from the source database and imports it into HANA with Software Provisioning Manager, as separate steps. DMO suits combined projects, while classical migration suits pure database moves.
Which tools are used for SAP HANA migration? The main tools are Software Update Manager with the Database Migration Option, Software Provisioning Manager for export and import, HANA backup and recovery, and HANA System Replication. SAP also offers self-service tools for moving to SAP HANA Cloud. Accelerators such as FLIP handle the reports, pipelines, and validation around the move.
Can I migrate from Oracle to SAP HANA? Yes. Oracle to SAP HANA is one of the most common heterogeneous migrations. Teams usually use DMO of SUM when an update or S/4HANA conversion is also planned, or classical export and import for a pure database move. Custom code checks and full-volume rehearsals are essential because data types and SQL behavior change.
How much downtime does SAP HANA migration need? Downtime ranges from minutes to a full weekend. HANA-to-HANA moves with System Replication can finish in minutes to a few hours, while large anyDB migrations often need a longer window. Archiving old data, table splitting, downtime-optimized DMO, and repeated mock runs are the main ways to shrink and confirm the window.
Is SAP HANA required for SAP S/4HANA? Yes. SAP S/4HANA runs only on the SAP HANA database. Enterprises on ECC with another database can move to HANA first and convert to S/4HANA later, or combine both steps using DMO. The right sequence depends on risk tolerance, available downtime, and the timeline before end of 2027 maintenance.
What happens to SAP ECC maintenance after 2027? SAP provides mainstream maintenance for SAP Business Suite 7 core applications until the end of 2027. Optional extended maintenance is available from 2028 until the end of 2030 at additional cost. Most enterprises use that period as a buffer for execution while they complete their move to HANA and S/4HANA.
Should I move SAP HANA to the cloud? Moving HANA to a hyperscaler or RISE with SAP reduces hardware management and makes scaling easier, while on-premises keeps more direct control. The choice depends on your cloud strategy, where your analytics platform runs, licensing, and in-house Basis skills. Many enterprises combine the database move with a cloud move.
How does FLIP help with SAP HANA migration? FLIP automates the work around the database move. It discovers the reports and pipelines that depend on SAP, converts legacy reports and pipelines to modern platforms such as Power BI and Microsoft Fabric, and validates outputs before and after cutover. That cuts manual effort, time, and cost across the program.
