TL;DR
The staff augmentation process is a seven-step lifecycle. It starts with diagnosing a delivery gap and ends with verified removal of the engineer’s access. Five of the seven steps happen before anyone writes a line of your code. Most delays come from the skill specification, the sourcing path, and access provisioning, not from the interview. A well-run engagement reaches real contribution in about three to four weeks. Every step has its own owner, its own duration, and its own way of failing.
Key Takeaways The staff augmentation process runs across seven steps, and five of them finish before an engineer touches your repository. Ask every provider one question in the first call. Is this a bench match or a fresh search? The answer moves your start date by weeks. Vetting for data, ML, and LLM roles needs different filters than generic developer screening, including a take-home task on a realistic dataset. Contracting, security classification, and access provisioning belong in parallel, never in sequence after signature. Track time to first merged commit, time to productive output, and knowledge-transfer completeness instead of tracking presence. Offboarding is a real step with evidence requirements, including access revocation, credential rotation, and accepted handover. The Week-Two Problem Nobody Budgets For Gallup puts a hard number on something engineering managers already suspect. Only 12% of employees strongly agree that their organization does a great job onboarding new people.
Watch on YouTube
IT Staff Augmentation Trends 2026: Pods Over Contractors
How augmented engineering engagements are actually being structured now, and what that changes about scoping, ownership, and the way you run the first ninety days.
That figure, of course, describes permanent hires who arrive with a start date, a manager, and a written plan. An augmented engineer usually arrives with less, and the shortfall surfaces as a week of unanswered questions inside your sprint.
A disciplined process closes that gap on purpose, before it costs a sprint. Treated properly, staff augmentation is a sequence of gates with named owners and real artifacts rather than a resume exchange. In this article, we’ll cover the seven steps, how long each one takes, the metric that proves it worked, and finally the failure that hides inside it.

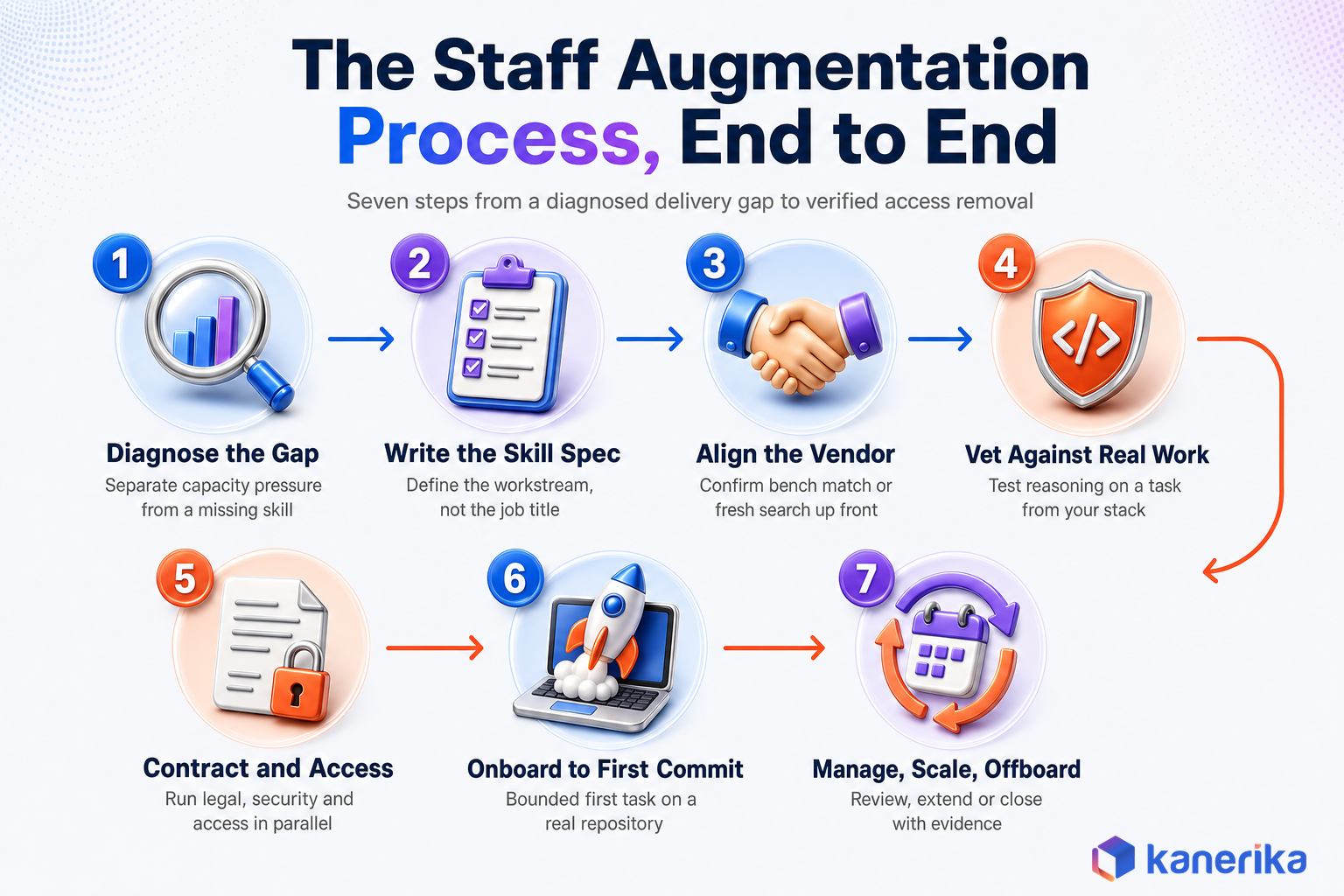

The Seven Steps at a Glance, With Owners and Durations Staff augmentation adds external engineers to your existing team under your direction, which is what separates it from handing a project to a vendor. Kanerika covers the model itself in a dedicated guide to staff augmentation , so this article stays on the lifecycle, from the first diagnosis to the last revoked account.
The ranges below are planning defaults for an enterprise engagement, rather than measured benchmarks. Their value is therefore comparative. When one step in your own engagement runs far past its range, that is where the process broke.
Step Planning duration Primary owner Artifact that closes it 1. Diagnose the delivery gap 2 to 5 days Engineering manager One-page problem statement 2. Write the skill specification 2 to 4 days Tech lead with the manager Weighted role scorecard 3. Align the vendor 2 to 3 days Manager and vendor account lead Agreed staffing plan 4. Source and vet candidates 3 to 10 days Vendor screens, client interviews Scored selection sheet 5. Contract and access readiness 3 to 7 days, run in parallel Procurement, legal, security Start-readiness checklist 6. Onboard to first contribution 5 to 10 days Assigned internal owner First merged pull request 7. Manage, scale, offboard Continuous, reviewed at day 30, 60, 90 Engineering manager Decision log and exit evidence
Full Scale, one of the few providers that publishes its own clock, describes an engineer joining in as little as seven days from approval with roughly two more weeks before that engineer is genuinely moving the roadmap. So three to four weeks to real contribution is a fair benchmark to hold your own engagement against.
Step 1: Diagnose the Delivery Gap Before You Request Resumes Every request for external engineers starts as a symptom. The backlog is growing, a milestone slipped, or a requisition has been open for four months. None of those symptoms, though, tells you what to buy.
Separate four different problems before anyone opens a vendor conversation. Temporary capacity pressure, for example, means you need more hands on work you already understand. A missing specialist skill means the work is blocked regardless of headcount. Unclear requirements and weak internal ownership are different problems entirely, and adding people therefore makes both worse.
Record the Baseline and Confirm Internal Ownership Write the baseline down while you still have it. Backlog age, missed milestones, current throughput, defect load, open-role duration, and the specific work blocked by the gap all become the evidence you review against when the ninety-day check arrives.
Do this at this stage. Before anything else, confirm that a named internal person can assign work, review output, make architecture calls, and accept delivery. Staff augmentation assumes that person exists, because the model carries no delivery manager of its own. When nobody inside can own the outcome, the work belongs in managed services or project outsourcing instead, and forcing a staffing model onto it produces an expensive contractor with nobody to point them at.

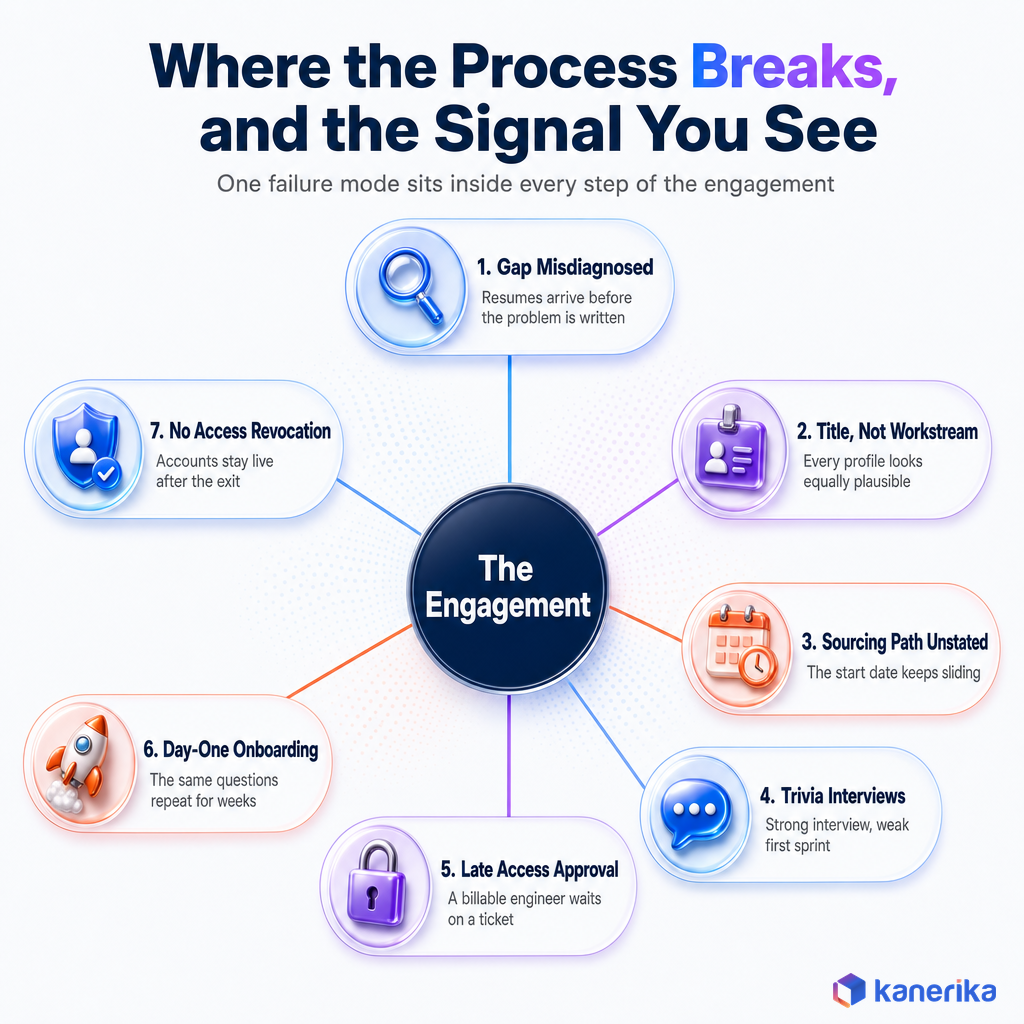

What breaks here. The gap gets described as a job title rather than a problem. The signal. Resumes start arriving before anyone has written down what success looks like, and the shortlist review turns into a debate about seniority instead of scope.
The output, then, is small and specific. One approved page covering the business deadline, the workstream, the missing capability, the duration, the headcount, and the contribution you expect.
Kanerika Service
IT Staff Augmentation for Data, Cloud, and AI Teams
Kanerika embeds vetted engineers into your existing delivery process, with the workstream scoping, security classification, and onboarding plan handled as part of the engagement.
Explore Staff Augmentation Step 2: Turn the Gap Into a Workstream and Skill Specification A job title is too blunt a filter. Three candidates can all be called senior data engineers and be useless to each other’s projects, because the platform, the data volume, and the delivery method differ.
Describe the workstream first, before any skills list. Name the system, the backlog it draws from, its dependencies, the delivery boundary, the technical risks, and the definition of done. Only then decompose the skills into required platform knowledge, engineering depth, domain experience, delivery method, and communication expectations.
Document the environment with the same care. Languages, frameworks, cloud services, repositories, CI/CD tooling, data sensitivity, deployment process, and required time-zone overlap all change who can actually do the work, so none of them is optional detail.
Do this at this stage. Get platform-specific about proof, too. A Microsoft Fabric assignment, a Databricks assignment, and a Snowflake assignment demand different production evidence even though every candidate carries the same job title. Ask for the specific thing they shipped on the specific platform, and write that requirement into the scorecard rather than leaving it to interviewer memory.
What breaks here. The specification lists technologies, but never names the acceptance standard. The signal. Every submitted profile looks equally plausible, and the interview panel cannot explain why they rejected anyone.
The artifact is therefore a weighted role scorecard that procurement and technical interviewers both use. Set the expected first contribution, the target ramp period, the review standard, and the measure of productive output before you see a single candidate.
Step 3: Align the Vendor on Scope, Timeline, and Sourcing Path Vendor selection deserves an intake meeting rather than an email thread. Reconcile your brief against the provider’s reading of it, covering seniority, start date, location, overlap hours, and any compliance limits before rates enter the conversation.
The single most useful question in that meeting, though, has nothing to do with price. Ask whether the candidates they will submit are already employed and available, or whether recruiting begins only after you approve the requirement.
Score Providers on Criteria You Can Verify Evaluate providers on criteria you can score rather than on brand familiarity. Kanerika also maintains a separate list of IT staff augmentation companies for shortlisting, and the model choices behind each engagement sit in the staff augmentation models guide .

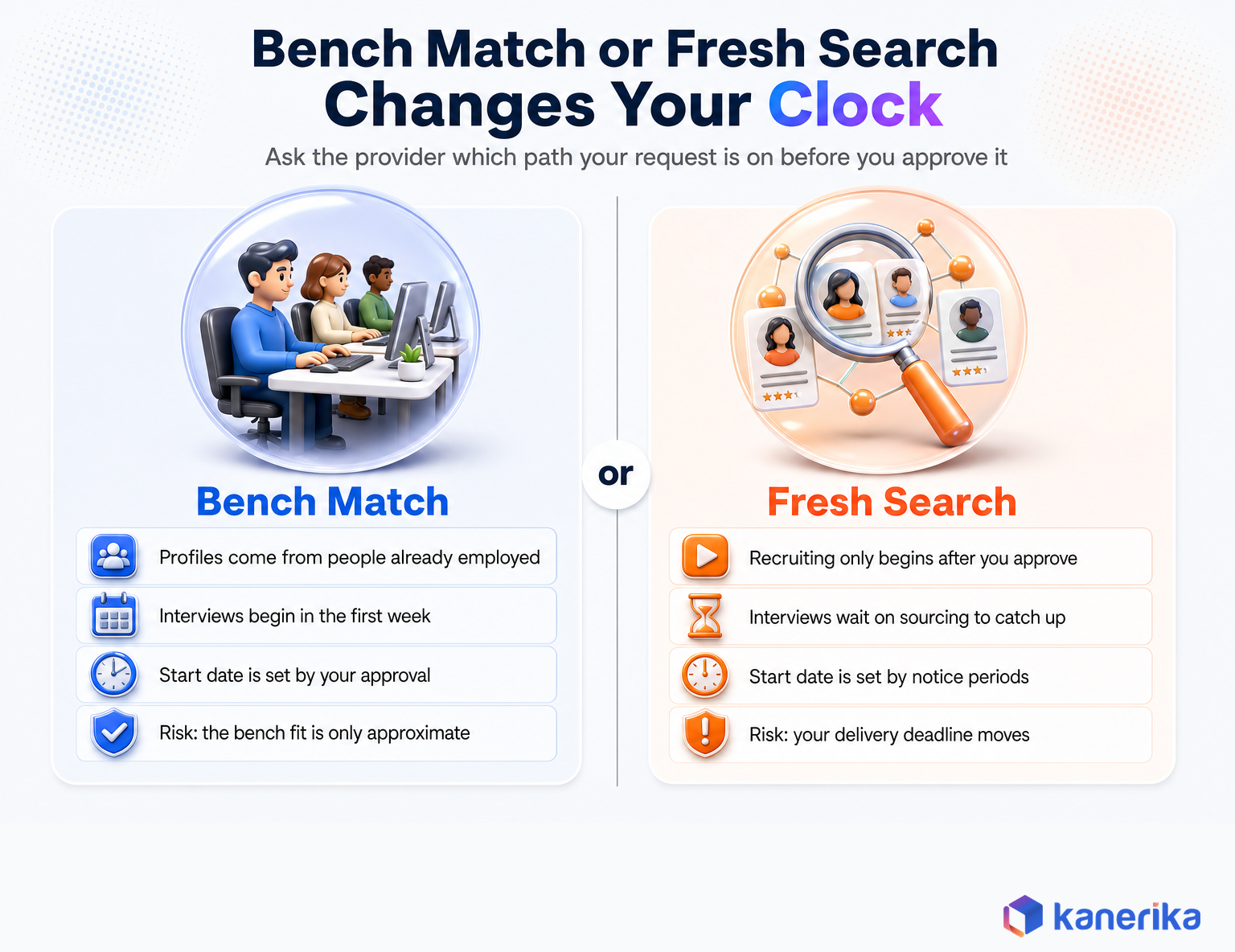

Criterion What to ask for Weak answer to watch for Sourcing path Named bench profiles with availability dates “We can find anyone you need” Platform depth Partner status and shipped production work Certifications with no delivery evidence Substitution control Named-resource clause in the contract Right to swap staff at their discretion Replacement terms Written trigger, notice, and handover duty Goodwill promises with no timeline Security posture Named certifications and access practices A policy document with no owner
Do this at this stage. Treat rate as one input among several rather than the deciding one. Regional rate differences are real and Kanerika breaks them down in the enterprise IT staff augmentation guide , but the number that governs your budget is cost per productive week, which depends on ramp speed far more than on hourly rate.
What breaks here. Nobody asks which sourcing path the request is on, so the timeline is a guess. The signal. The promised start date slips twice with no explanation, because recruiting quietly began after approval.
Close this step, finally, with an agreed staffing plan covering the sourcing route, the submission date, the interview window, the backup-candidate plan, and the escalation owner.
Datasheet
IT Staff Augmentation Services for AI, Data & Cloud Teams
A one-page summary of engagement models, role coverage, and the delivery controls Kanerika applies before an external engineer touches a client system.
View the Datasheet → Step 4: Vet Candidates Against Work That Resembles Yours Provider pre-screening should already have verified identity, employment history, claimed certifications, real availability, and written communication before your first call. Your interview exists to test something else entirely, namely whether this person can reason inside your environment.
Ask for an evidence packet before the call. Architecture decisions they owned, work samples where permitted, incident examples, delivery outcomes, and references tied to comparable work are all worth more than a chronological resume.
Then run the interview against a realistic task drawn from your own stack rather than algorithm trivia. A production scenario works better still. Ask how they would diagnose a failure, protect sensitive data, review a colleague’s code, document a decision, and escalate when they are unsure.

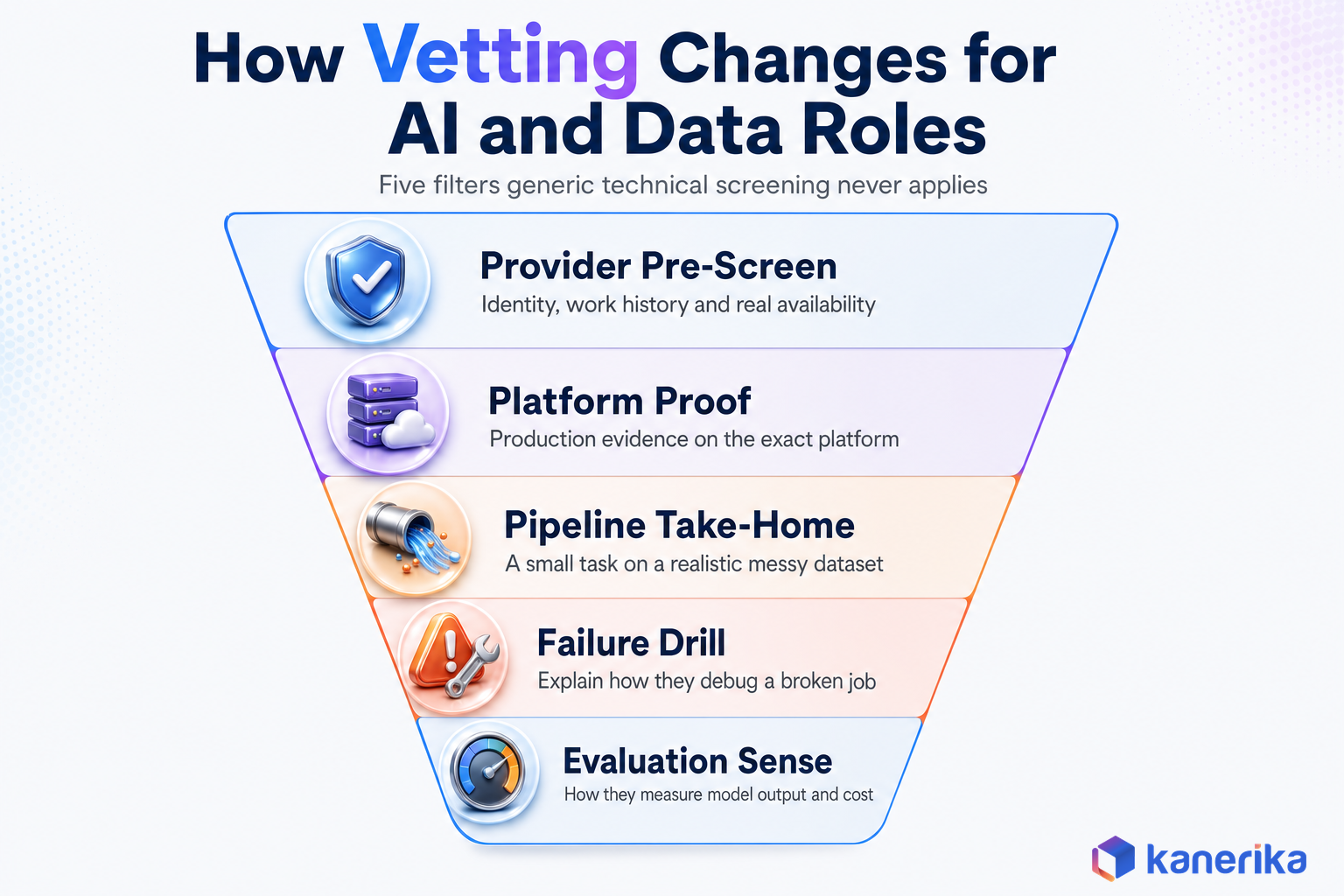

How Vetting Changes for AI and Data Roles Generic developer screening still misses the failure modes that matter for data and AI work. S&P Global Market Intelligence surveyed more than 1,000 organizations and found that 42% abandoned most of their AI initiatives , up from 17% a year earlier, with the average organization scrapping 46% of proof-of-concepts before production. Cost, data privacy, and security risk led the reasons, rather than modelling ability.
So test for the things that actually stall those projects. Ask for a small take-home on a realistic, slightly messy dataset instead of a clean one. Ask how they debug a pipeline that failed at 3am and how they would tell whether a model’s output got worse this month.
Kanerika applies this pattern when placing data engineers, ML engineers, and MLOps specialists through its data engineering hiring practice , and covers role-level detail in a separate AI staff augmentation guide .
Team fit deserves a separate check, though it is not about personality. Confirm working hours and real overlap, look at how they write when the question is ambiguous, and see how they respond to a piece of critical feedback during the interview itself.
What breaks here. The interview measures recall instead of judgment. The signal. A candidate interviews strongly and then produces a weak first sprint, because nobody tested how they behave when the requirements are ambiguous.
Record scores, concerns, conditions, rejection reasons, and the final approver in one auditable decision sheet before you close the step. That sheet becomes the reference point if a replacement is needed later.
Step 5: Run Contracting, Security, and Access Readiness in Parallel Most lost time in staff augmentation hides in this step, because teams run it in sequence. Contract signs, then security reviews, then IT provisions accounts, and a billable engineer spends the first week waiting on a ticket.
Start all three tracks on the day you select a candidate, so nothing waits on signature. The commercial schedule covers named resources, rates, billing basis, start date, minimum term, extension rules, notice periods, replacement terms, and non-billable conditions. Legal, meanwhile, covers confidentiality, IP ownership, work-product assignment, data handling, subcontracting, and post-engagement obligations. The billing basis named in that schedule is a commercial choice of its own, drawn from the standard software development pricing models .
Security classification runs alongside both, rather than after them. Map the role to the data, systems, environments, repositories, and production privileges genuinely required, then assign system owners, approval dates, account expiry dates, MFA requirements, and logging for each one.
Do this at this stage. Provision to least privilege, and set an expiry date on every account when it is created. Verizon’s 2025 Data Breach Investigations Report found that credential abuse accounted for 22% of initial attack vectors , with third-party involvement in breaches doubling year over year. External engineers are, of course, exactly the population where standing over-provisioned access accumulates.
Listen on Spotify
Can IT Staff Augmentation Help Enterprises Scale Faster?
What breaks here. Access approval starts after the contract rather than beside it. The signal. Day one is spent on introductions because the repository permission is still pending.
Gate the start. No billable delivery until the contract, identity checks, hardware, access approvals, manager assignment, and onboarding schedule are all complete and recorded on one checklist.

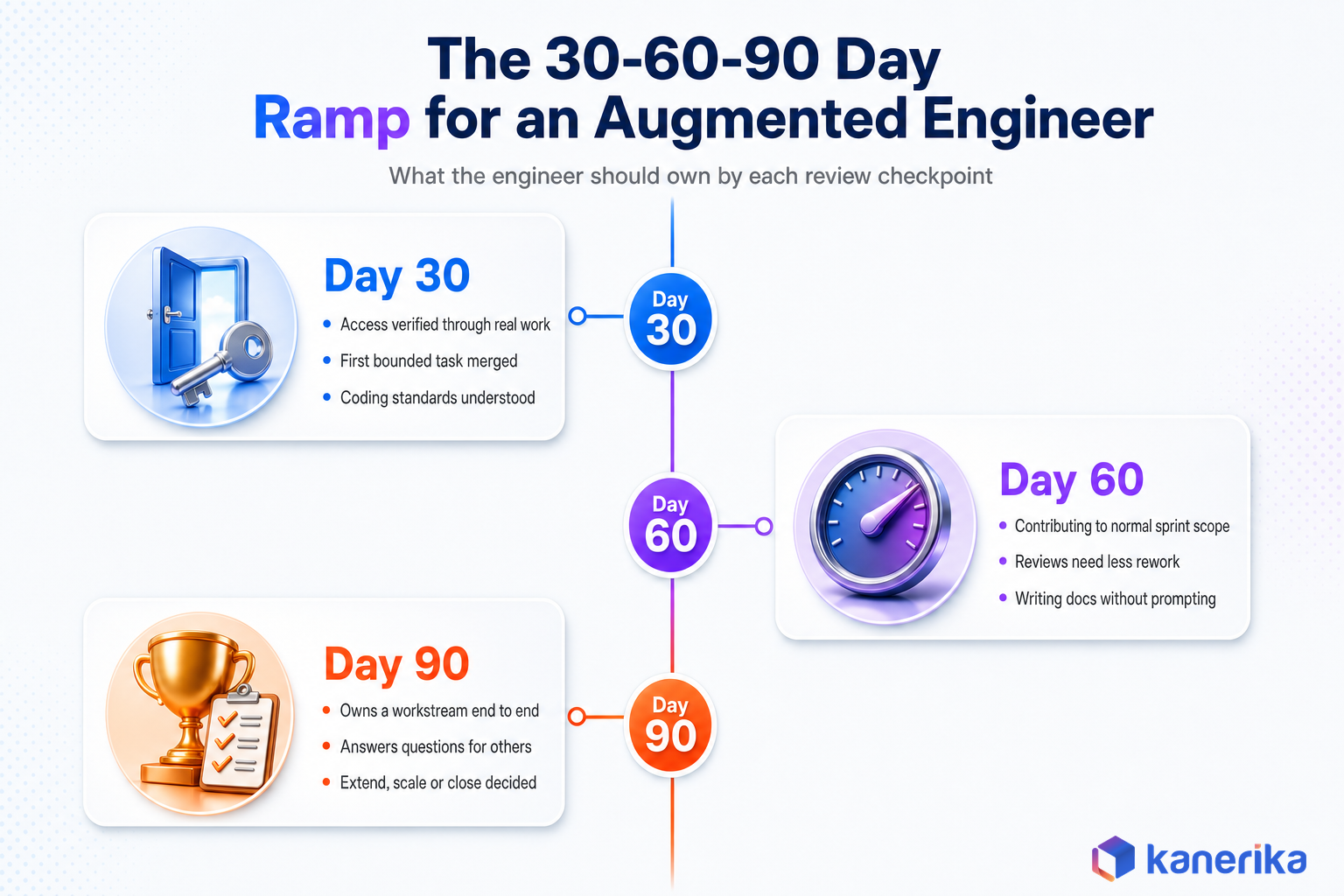

Step 6: Onboard Toward a First Production Contribution Onboarding an augmented engineer is not a lighter version of onboarding an employee, though it often gets treated that way. It is the same work compressed, because the engagement is shorter and the ramp cost is billable.
Send the preboarding package before the start date. Architecture material, a glossary, the team chart, coding standards, security rules, backlog context, and the meeting schedule let the engineer arrive with questions rather than confusion.
Validate access through real work on day one instead of trusting a provisioning ticket. Have them clone the repository, run the build, open a test branch, and then reach the environments they need. Anything that exceeds the approved role profile gets removed the same day.
Do this at this stage. Assign a bounded first task that touches the full workflow before it touches a critical release. Code, review, test, document, deploy. The point is to exercise every handoff once while the stakes are low, and Kanerika’s staff augmentation best practices go deeper on the integration habits that make this stick.
What breaks here. Onboarding is treated as a day-one event rather than a thirty-day plan. The signal. The same questions come back in standup for three weeks, while the engineer’s pull requests keep failing review on conventions nobody wrote down.
Move the engineer into normal backlog ownership only when code review, documentation, security, and team-working standards are all met. That acceptance moment, then, is the real start of the engagement.
Step 7: Manage Delivery, Then Scale, Extend, or Offboard Day-to-day direction sits with you, and it certainly should. The provider handles employment support, continuity, and replacement readiness, while your manager gives feedback on the work itself. The provider stays the engineer’s employer throughout, which is the structural difference between an augmented team and the two options weighed in employee versus contractor .
Run the delivery loop inside your existing process rather than beside it. Backlog assignment, daily coordination, code review, testing, release approval, documentation, and feedback all use the same mechanics your permanent engineers use, too.
Watch a short list of early-warning signals while the work runs. Repeated access delays, unclear ownership, excessive rework, missed overlap hours, thin documentation, or one person becoming the only route to a subsystem all predict trouble before a milestone slips.
Do this at this stage. Write knowledge down during delivery instead of reconstructing it at departure. Decisions, runbooks, code context, and operating notes updated weekly turn offboarding into a checklist rather than an archaeology project.
Agree the correction path before you need it. A written improvement period, a support action from the provider, a reassignment rule, and a replacement trigger all belong in the contract rather than in an awkward conversation three weeks before a release.
Replacing, Scaling, and Closing the Engagement A replacement mid-engagement is, in effect, a small version of the whole process. Preserve the knowledge first, revoke the departing engineer’s access, validate the incoming engineer against the original scorecard, and run a focused handover rather than starting the specification again.
Scaling decisions get the same discipline, too. Before adding an engineer, confirm the backlog, management capacity, environments, and onboarding support can absorb one. Before removing one, identify work completion, handover dependencies, access expiry, and notice obligations. Time-zone overlap changes both calculations, which Kanerika covers in its guide to offshore staff augmentation .
Offboarding, finally, closes with evidence. NIST SP 800-171 Revision 3’s personnel termination and transfer control requires organizations to disable system access within a defined time period, terminate or revoke the individual’s authenticators and credentials, and retrieve security-related system property. That is a reasonable bar for any external engineer, whether or not you handle controlled information.
What breaks here. Offboarding is treated as an HR formality rather than a control. The signal. An audit months later finds active accounts belonging to engineers who left, and shared credentials nobody rotated.
The Metrics That Prove Each Step Worked Most engagements are measured on presence, which means the number tells you nothing. SHRM’s 2025 benchmarking research found that only 20% of organizations track quality of hire at all, and augmented staff are usually measured even more loosely than permanent ones.
Attach one measure to each step so a problem surfaces where it started rather than at the end.
Step Metric Healthy signal Diagnose the gap Blocked work identified Named backlog items, not a headcount number Skill specification Scorecard agreement rate Interviewers score within one band of each other Vendor alignment Time to first qualified submission Profiles that pass screening on the first pass Sourcing and vetting Interview-to-offer ratio Rejections trace to written scorecard reasons Contract and access Access-ready date versus start date Every account live before day one Onboarding Time to first merged commit A real change merged inside the first week Active delivery Time to productive output Sprint contribution matches the ramp assumption Offboarding Knowledge-transfer completeness An internal owner reproduced every procedure
Cycle time, review rework, escaped defects, and blocked hours also belong in the same review. Raw ticket counts do not, because they reward the wrong behaviour in exactly the population you have least visibility into.
How This Process Held a Platform Together Through an Acquisition A private equity-backed data preparation software company was acquired by a larger analytics business, which created two mandates at once. Existing enterprise customers depended on connectors that could not break, while internal teams needed to build cloud-native capability during a hiring freeze.
Kanerika then ran the lifecycle described above as a dual-track engineering model. One track took full product ownership of legacy platform stability, covering connector frameworks and integration pipelines from design through post-release support. A second track built new connectors and cloud integrations, with implementation and customer-success coverage across the US and APAC as an extension of the client’s own delivery teams.
The published outcomes were a 60% reduction in connector development costs, roughly 40% lower professional services implementation costs, and a 40% lower cost to run the legacy platform. More than $40M in recurring revenue was preserved through the transition, and a new delivery center was operational within 90 days.
Case Study
60% Lower Connector Development Costs Through an Acquisition
Kanerika ran a dual-track embedded engineering model for a data preparation platform during an acquisition, cutting connector development costs by 60% and professional services implementation costs by roughly 40% while preserving more than $40M in recurring revenue.
Read the Case Study → The decisions that produced those numbers were, above all, process decisions. Scoping the workstream before naming roles, keeping named resources tied to the people actually interviewed, and treating knowledge capture as a delivery task rather than an exit task.
Kanerika runs the same lifecycle through its IT staff augmentation practice and its product engineering teams , with ISO 27001, ISO 27701, and CMMI Level 3 credentials sitting behind the access and delivery controls described in steps 5 and 7.
Wrapping Up The staff augmentation process rewards preparation far more than speed. Five of its seven steps finish before an engineer opens your codebase, and that is where most of the recoverable time sits.
So run the steps as gates with owners and artifacts. Write the problem down, specify the workstream instead of the title, force the sourcing path into the open, vet against real work, run contracting and access in parallel, and onboard toward a merged commit rather than a start date.
Talk to Kanerika
Planning an Augmented Engineering Engagement?
A short working session turns your delivery gap into a scoped workstream, a role scorecard, and a realistic start date, before any resumes change hands.
Talk to Kanerika → Then close it properly. An engagement is finished when the contribution is accepted, the knowledge sits with an internal owner, and every account is verifiably gone.
Frequently Asked Questions
How long does the staff augmentation process take? Plan on three to four weeks from approved requirement to real contribution. Sourcing and vetting take three to ten days, contracting and access readiness three to seven when run in parallel, and onboarding another five to ten. A bench match compresses the front half; a fresh search adds weeks because recruiting only starts after you approve.
What are the steps in the staff augmentation process? Seven steps. Diagnose the delivery gap, write the workstream and skill specification, align the vendor on scope and sourcing path, source and vet candidates, run contracting and access readiness in parallel, onboard toward a first production contribution, then manage delivery and scale, extend, or offboard with evidence.
Who manages the augmented engineer, the client or the vendor? The client manages the work. You assign tasks, review output, make architecture decisions, and accept delivery, exactly as you would for an internal engineer. The provider handles employment, payroll, continuity, and replacement readiness. When nobody internal can own the outcome, the engagement belongs in managed services instead.
Do I get to interview staff augmentation candidates before they join? You should, and a provider that resists is a warning sign. Interview against a realistic task from your own stack rather than algorithm trivia, and tie the contract to the named people you actually interviewed so nobody is substituted later. Record scores and rejection reasons in one decision sheet.
What should a staff augmentation contract include? Named resources, rates, billing basis, start date, minimum term, extension rules, notice periods, replacement terms, and non-billable conditions. On the legal side, cover confidentiality, IP ownership, work-product assignment, data handling, subcontracting, and post-engagement obligations. Add a written improvement period and replacement trigger before you need either one.
What is the difference between staff augmentation and outsourcing?
What happens if an augmented engineer is not working out? Use the correction path you agreed at contracting. A written improvement period, a support action from the provider, then a replacement trigger. Preserve the knowledge first, revoke the departing engineer’s access, validate the replacement against the original scorecard, and run a focused handover rather than restarting the specification.
What evidence should IT retain after an augmented engineer is offboarded? Keep the access approvals and revocation logs, asset return receipts, credential rotation records, the accepted knowledge handover, contractual closure documents, and the final delivery record. NIST SP 800-171 Revision 3 expects access disabled within a defined period, authenticators revoked, and security-related property retrieved.
