In March 2026, Microsoft launched the Azure Copilot Migration Agent to advance automation in migration planning. Engineers were quick to point out that the agent covers the planning phase well, generating dependency maps, landing zone templates, and wave plans, but stops before the actual migration begins. Replication, cutover, and execution still require manual work, which means the hardest and most error-prone parts of any migration remain unsolved.
According to the Flexera 2026 State of the Cloud Report, 85% of organizations cite managing cloud costs as their top challenge, and budgets are still being exceeded by 17% on average. Migration complexity drives much of that overrun, with business logic lost at transformation, dependencies surfacing mid-project, and validation running on data samples that miss what actually breaks in production.
In this article, we’ll cover why manual migration fails at specific stages, what automation changes at each one, where business logic tends to disappear, and how Kanerika’s FLIP platform handles it end-to-end.
Key Takeaways
- Manual migration fails at predictable stages, and the damage compounds across assessment, transformation, and validation before anyone catches it.
- Each migration stage carries a different risk profile, and the most expensive failures consistently come from transformation and validation, not from the discovery work that gets the most attention.
- Business logic embedded in legacy systems is the most common source of post-migration failures, and most tools do not address it specifically.
- FLIP, Kanerika’s proprietary workflow automation platform, automates up to 80% of migration tasks across all six stages, with purpose-built accelerators for Informatica, Azure, and UiPath environments.
- Enterprises using FLIP see up to 90% reduction in migration timelines and 50-60% reduction in effort, tracked stage by stage.
Automate Your Data Platform Migration With FLIP Today!
Partner with Kanerika for Expert Data Migration Services
Why Manual Migration Fails at Specific Stages ?
Most migration failures do not happen all at once. They build quietly across stages, with each missed detail in assessment creating a more expensive problem at transformation, and every untested edge case in validation surfacing as a production incident after go-live. Understanding where the breakdowns happen is what makes automation decisions practical rather than speculative.
1. The Problem with Assumption-Driven Migration Assessments
Manual assessment relies on interviews, documentation reviews, and manually catalogued inventories of data sources, applications, and dependencies. For large environments, this takes weeks and produces a spreadsheet that is already partially outdated by the time it is finished. Hidden dependencies that were never documented surface mid-project, each one extending scope and pushing timelines out further.
2. Transformation Moves the Code but Leaves the Logic Behind
Legacy systems accumulate business rules over years, embedded in stored procedures, field naming conventions, transformation logic, and sometimes in institutional memory rather than documentation. When a migration project moves data and code without specifically extracting and preserving that logic, the new system behaves differently from the old one in ways that are hard to trace.
3. Gaps in Manual Validation Processes
Validation is where teams check their work before go-live, but manual validation typically runs on a representative sample of the data rather than the full dataset. The assumption is that the sample is representative. It rarely is. Null-value sorting differences between database engines, special character handling, max-length field edge cases, and complex business rule outputs all tend to concentrate in the portions of the data that sample-based testing does not reach. The result is a go-live that passes validation, followed by production incidents that the validation process was supposed to prevent.

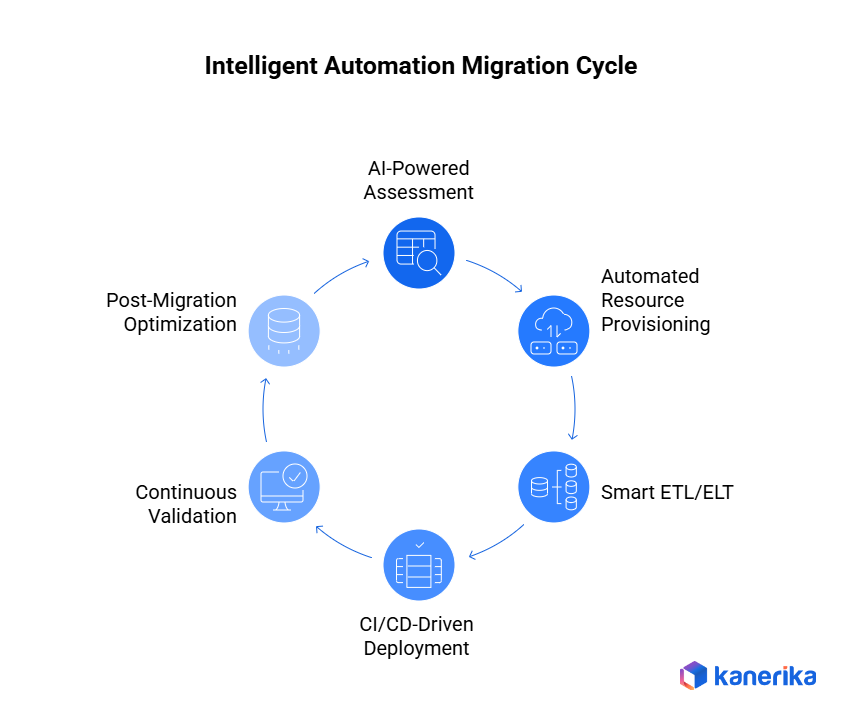

What Automation Changes at Each Migration Stage
The difference automation makes is not uniform across migration. At assessment, it compresses weeks of manual discovery into days.
Then, at transformation, it removes the manual scripting that produces the most errors. Next, at validation, it replaces sampling with full-dataset checks. At post-migration, it runs the monitoring that most teams never get to. Each stage has a specific problem that automation addresses in a specific way, and understanding that distinction is what separates a realistic automation strategy from a general claim that automation makes migration faster.
1. Assessment: From Static Inventory to AI-Driven Discovery
AI-driven discovery tools scan the entire environment programmatically, building dependency maps across applications, databases, and APIs in days rather than weeks. The output is queryable and current, not a document that ages from the moment it is written. With FLIP, assessment goes further:
- Parses existing code and pipeline definitions to extract embedded transformation logic before any migration work begins
- Produces a dependency map that accounts for business rules, not just system relationships
- Flags high-complexity workloads that need engineer review before migration starts
- Scopes timeline and effort from real environment data, not estimates built on assumptions
2. Reducing Setup Errors with Standardized Environments
Manual environment setup means configuring networks, security groups, access controls, and compute resources by hand, often across multiple environments that are supposed to match. Configuration drift is common and typically only appears during testing, after migration work has already started. Infrastructure as Code templates provision entire target environments in minutes from a defined specification, applied consistently every time. FLIP validates the target environment before any data movement begins, catching misconfigured security settings, storage tier mismatches, and access control gaps before they become blockers mid-migration.
3. Data Transformation
Transformation is where most manual migration projects lose months. Mapping schemas across source and target systems, handling format mismatches, standardizing inconsistent data, and applying business rules across thousands of tables requires specialized skills and produces errors at a rate that compounds with volume.
FLIP handles this automatically:
- Parses source schemas and extracts embedded business logic before transformation begins
- Generates target-ready structures without manual field mapping
- For Informatica to Databricks migrations, converts PowerCenter mappings into optimized Spark code or Databricks notebooks, preserving ETL logic built over decades
- For Azure to Microsoft Fabric migrations, maps Data Factory pipelines to Fabric’s unified architecture without manual rebuilding
What typically takes specialist teams three to six months is completed in weeks.
4. Code and Workflow Conversion
Application and workflow migration involves rewriting or refactoring code to function in the target environment, a process that is prone to logic loss when original developers are unavailable and documentation is incomplete. FLIP converts UiPath XAML workflow definitions into Microsoft Power Automate flows, preserving trigger logic, exception handling, and action sequences through the conversion. For BI migrations, it analyzes report logic from Crystal Reports, SSRS, or Cognos and generates Power BI-ready structures with original formulas intact. The result is up to 80% automation of the conversion process, with engineers focused on reviewing outputs rather than rebuilding from scratch.
5. Reliable Validation Before Cutover
Automated test suites run checks across the full dataset rather than a sample, comparing row counts, verifying checksums, and testing business logic outputs against source system results. FLIP runs automated reconciliation before cutover is approved:
- Compares source and target at row level, not just schema level
- Verifies business rule outputs against live source system results
- For RPA migrations, runs converted flows in parallel with live source robots before any decommissioning is approved
- Flags every discrepancy for engineer review before go-live, not after
Cutover is approved only after validated parity, not because a deadline arrived.
6. Post-Migration
Most teams declare success at go-live and shift attention elsewhere. The target environment runs as provisioned, regardless of whether that provisioning still matches actual usage patterns weeks later, and cloud costs rise as over-provisioned resources sit idle. FLIP monitors performance continuously after go-live, tracking against the baseline established at assessment. For data lakehouse migrations, it monitors query performance and pipeline execution times, surfacing bottlenecks that only appear under production-scale workloads. This is where the long-term cost savings from migration are actually realized, not at go-live, but in the months that follow.
The Impact of Ignoring Business Logic in Migration Projects
Business logic is the collection of rules, calculations, and decisions that determine how a system behaves: which transactions trigger which workflows, how data is categorized, which exceptions route to manual review. In most production systems, this logic does not live in clean documentation. It lives in stored procedures, field naming conventions, transformation rules, and the institutional knowledge of people who have worked with the system for years. When a migration moves code and data without extracting that logic first, the new system behaves differently from the old one in ways that are genuinely hard to trace.
The consequences show up in specific, recognizable ways:
- Reports produce different totals than the source system, with no obvious cause in the data
- Workflow routing rules that functioned correctly before cutover stop triggering under certain conditions
- KPI calculations drift between regions because transformation rules were not standardized before migration
- Validation passes at go-live but production incidents surface weeks later as edge cases hit the new system
- Finance or operations teams flag discrepancies that require engineering to reconstruct logic from legacy code that is no longer running
FLIP addresses this at every stage.
At assessment, it parses existing code and pipeline definitions to extract transformation logic before migration begins. At transformation, it preserves that logic during conversion rather than producing syntactically equivalent code that behaves differently under edge cases.
| Area | Common Issue | Impact on Migration | Recommended Approach |
| Logic Location | Logic spread across code and systems | Key rules are missed | Extract logic from code and workflows early |
| Documentation | Outdated or incomplete | Reliance on assumptions | Validate logic from live systems, not docs |
| Migration Process | Focus on data and structure only | System behavior changes post-migration | Preserve logic during transformation |
| Edge Cases | Not captured or tested | Errors in outputs and workflows | Identify and include edge cases in testing |
| Validation | Sample-based validation | Logical gaps go undetected | Perform full, row-level validation |
| Post Go-Live | Late issue discovery | Costly fixes and delays | Verify logic before deployment |
AI Closes the Gaps That Standard Automation Cannot Reach
Standard automation handles repeatable tasks consistently. AI handles the judgment calls, the patterns that automation cannot detect because they require understanding context across a system rather than executing a defined rule within one. Three areas where this difference is most significant in migration:
1. Predictive Risk Flagging at Assessment
Machine learning models analyze historical migration data, system logs, and dependency maps to identify risk patterns before migration begins. An AI system can flag a legacy database schema as high-complexity and likely to cause transformation errors based on patterns from previous migrations, before a human team would identify it through manual review. This shifts risk identification from a reactive process that discovers problems mid-project to a preventive one that addresses them before migration starts.
2. Generative AI for Code and Schema Conversion
Generative AI interprets legacy code logic and generates equivalent code for target platforms, going beyond rule-based syntax conversion. In Informatica migrations, this means FLIP understands the business rules embedded in PowerCenter transformation logic and recreates them accurately in Databricks notebooks, rather than converting syntax and leaving the logic to be verified manually. The difference between converting code and understanding what it does is where most automated migration tools stop and where FLIP continues.
3. Agentic Monitoring After Cutover
Agentic AI monitors execution after go-live, detects anomalies, and adapts workflows without requiring constant human oversight. These AI agents learn from each migration engagement, applying patterns from previous projects to improve detection accuracy and reduce the manual investigation time required when something deviates from expected behavior post-migration.
How FLIP Accelerates Migration Across Complex Environments
FLIP is Kanerika’s intelligent workflow automation platform built for autonomous enterprise migration. It automates up to 80% of migration tasks from assessment through post-migration monitoring, with purpose-built accelerators for the migration scenarios that consume the most time and carry the highest risk of logic loss.
1. Informatica to Databricks
FLIP parses Informatica PowerCenter mappings, transformations, and workflows and converts them into optimized Spark code or Databricks notebooks. The conversion preserves complex ETL logic end-to-end rather than requiring manual recoding of transformation rules. Clients using FLIP for this migration see up to 90% reduction in migration timelines compared to manual conversion approaches.
2. Azure to Microsoft Fabric
FLIP converts Azure Data Factory pipelines and modernizes Synapse workspaces, mapping components to Microsoft Fabric’s unified architecture. The conversion handles the structural mapping and dependency translation that makes manual Azure to Fabric migrations time-consuming, allowing engineering teams to focus on validation rather than conversion work.
3. UiPath to Power Automate
FLIP reads UiPath XAML workflow definitions and converts them into Microsoft Power Automate flows, preserving trigger logic, exception handling, and action sequences through the conversion. Converted flows run in parallel with live UiPath robots before any decommissioning is approved, confirming output parity before the switch. Clients see up to 75% reduction in annual licensing costs within 90 days of migration.
Across FLIP engagements, clients see 50-60% reduction in migration effort and 40-60% faster loading times post-migration. 50 to 100 pipelines are completed in 2 to 3 weeks. 500 or more pipelines in 6 to 8 weeks. Manual equivalents for those scopes run 6 to 12 months. Kanerika operates as a Microsoft Solutions Partner for Data and AI, a Databricks Implementation Partner, and a Snowflake Consulting Partner, with ISO 27701, SOC II Type II, CMMI Level 3, and GDPR compliance across all engagements.
How FLIP Helped Achieve 60% Faster Processing in Migration from Informatica to Microsoft Fabric
A global consumer electronics brand managing operations across multiple international markets needed to migrate from Informatica batch pipelines to Microsoft Fabric. What follows is what broke, what Kanerika changed, and the measured outcome.
The Challenge
Growing product and order volumes overwhelmed the existing Informatica pipelines. Refresh cycles slowed, sales planning ran on stale data, and regional teams operated on inconsistent KPI definitions, making a unified global view impossible and every reporting cycle a manual reconciliation exercise.
The Solution
Kanerika migrated high-volume data flows to Microsoft Fabric using FLIP’s migration accelerator, covering three areas:
- Moved data flows to Fabric with stable refresh cycles maintained throughout, even as production volumes grew
- Replaced overnight batch runs with optimized Fabric data paths, giving business teams same-day access to sales and supply data
- Established a standardized KPI and rule framework across all regions, eliminating the inconsistencies that had prevented a single trusted global view
The Results
- 60% improvement in data processing speed
- 42% reduction in infrastructure costs
- 76% faster time-to-insights for business teams
- Manual reconciliation work eliminated across all regional reporting cycles
Wrapping Up
Migration fails at specific stages for specific reasons, and the pattern is consistent enough that it is predictable. Assessment misses dependencies. Transformation loses logic. Validation covers a sample, not a dataset. Post-migration optimization never happens. Automation addresses each of these at the stage where the problem originates, which is what makes it a structural fix rather than a general speed improvement.
FLIP is built around that reality. It handles the stages that manual execution handles worst, preserves what manual execution most often loses, and gives teams visibility at each phase rather than a final report at project close. For enterprises planning a migration, the starting point is a realistic assessment of what the source environment actually contains, not what the documentation says it contains. That is where the work begins, and where the outcome is largely determined..
Simplify Your Data Migration with Confidence!
Partner with Kanerika for a smooth and error-free process.
FAQs
1. What is the Role of automation in migration for modern enterprises?
Automation streamlines data and application migration by reducing manual effort, minimizing errors, and accelerating timelines. It ensures consistency, improves scalability, and reduces downtime. For enterprises, this means faster access to analytics, better compliance, and lower operational costs while maintaining business continuity.
2. How does AI enhance the Role of automation in migration beyond traditional tools?
AI adds intelligence to automation. It uses predictive analytics to detect bottlenecks, machine learning to improve accuracy, and generative AI to automate schema or code conversion. This results in faster migrations, improved data quality, reduced risk, and significantly higher efficiency compared to rule-based automation alone.
3. What migration challenges does automation solve most effectively?
Automation addresses three major challenges:
- Data integrity issues caused by manual errors
- Project delays and cost overruns due to repetitive tasks
- Complex legacy system transitions requiring specialized skills
Intelligent automation platforms reduce manual effort by up to 50–60% and accelerate project timelines significantly.
4. Can automated migration be customized for specific industries and tech stacks?
Yes. Modern automation platforms are modular and adaptable. They align with industry regulations, compliance standards, and existing technology ecosystems. Pre-built accelerators can be tailored to specific tools, cloud platforms, and enterprise environments to ensure seamless integration.
5. What measurable ROI can organizations expect from automated migration?
Organizations typically experience:
- Up to 90% faster migration timelines
- 50–60% reduction in manual effort
- Lower licensing and infrastructure costs
- Faster post-migration processing and performance improvements
These gains translate into faster time-to-value and improved operational agility.
6. How does automation ensure security and compliance during migration?
Automation embeds validation, encryption, access controls, and audit tracking into every migration stage. It supports global compliance standards and ensures secure data transfer, minimizing risk while maintaining regulatory adherence throughout the migration lifecycle.
