TL;DR
A cloud transformation strategy should start with the results the business wants and the data its AI needs. Then it makes six decisions, picks a migration path for each system and moves in phases. If a data center lease ends soon, move systems as they are and improve them later. If AI work is stuck on scattered data, fix the data platform first. When rules limit where data can live, keep that data in place and move the rest. Only 7% of companies say their data is completely ready for AI, so treat data readiness as the test of success.
Key Takeaways A cloud transformation strategy changes how the business runs on cloud, while a migration only changes where systems run. Six decisions shape every strategy, starting with outcomes and then workloads, deployment model, data platform, ownership and success measures. The 7 Rs give each workload its own path, such as retire, retain, rehost, replatform or refactor. Moving data to the cloud does not make it AI-ready, so data readiness belongs in the plan from day one. Flexera’s 2026 survey puts wasted cloud spend at 29%, so FinOps belongs in the strategy from the start. Build the roadmap in phases with an exit test for each, then review cost, reliability and data freshness every quarter. Watch on YouTube
Why Data Platform Migration Succeeds or Fails: The Business Analysis Factor
A migration can finish on schedule and still miss its purpose. This video explains why the business analysis done up front decides whether a data platform move succeeds.
The Migration Finished on Time. The AI Pilot Still Could Not Start. Picture a retailer that moves 300 virtual machines to the cloud in nine months, right on schedule. The steering committee celebrates. But then the first full monthly invoice arrives, and it is higher than the old data center budget.
A quarter later, the data science team asks for a single customer view to train a churn model. The customer data still sits in the same 14 databases, now on rented hardware instead of owned hardware. The team has nothing to train on, and the pilot cannot start.
Nothing went wrong with the migration itself. Instead, nobody decided what the move was for. A cloud transformation strategy answers that question first, because it sets the outcomes, the systems that change and the proof that it worked.
This guide walks through those decisions in order. It also covers readiness, the 7 Rs, a phased roadmap, costs, governance and where data and AI fit, along with a worked example.
What Is a Cloud Transformation Strategy? A cloud transformation strategy is a business plan for changing how an organization builds, runs and pays for technology using cloud services. It also decides which systems move, change or stay, and what the business gains from each choice.
The word that matters is transformation. For example, moving a payroll application from a rack in your data center to a virtual machine in Azure is a migration. Transformation, on the other hand, means redesigning how payroll data flows into finance reporting, who owns it and what each run costs. The plan covers both, but it is judged by the second.
The three terms below get used interchangeably in vendor material, so they cause real confusion in budget meetings. Here is how they differ in practice.
Cloud Transformation vs Cloud Migration vs Cloud Modernization Each term describes a different scope of change, and each usually has a different owner. Treat migration and modernization as tools inside the larger transformation plan.
Term Scope Goal Typical output Usual owner Cloud migration Moving workloads and data to cloud infrastructure Exit hardware or meet a deadline Workloads running in the cloud with a similar design Infrastructure or IT operations Cloud modernization Changing how specific applications or data platforms are built Lower run cost and better scalability Managed services, containers, a modern data platform Application and data engineering teams Cloud transformation Changing the operating model, funding, governance and data use across the business Measurable business outcomes and AI readiness A roadmap, a cloud operating model and KPIs tied to outcomes CIO or CTO with business sponsors
A company can finish a migration and still have no transformation. That is exactly what happened to the retailer, even though its migration ran on time.
Where Cloud Adoption and Digital Transformation Fit Cloud adoption is the broader pattern of an organization using more cloud services over time, often team by team. It generally shows up as SaaS subscriptions, a few cloud databases and developer accounts on two or three providers.
Digital transformation is wider still. It covers how a business uses technology to change products, customer experience and operations, while cloud is one enabler among several. The cloud strategy sits between the two, so it turns scattered cloud adoption into a deliberate program that serves those digital goals.
Why a Cloud Transformation Strategy Matters in 2026 The case for a deliberate plan has grown stronger, because AI ambitions and rising cloud bills now land in the same budget meeting. Security and data residency rules then shape what is possible. Three pieces of 2026 evidence show why each one matters.
AI Readiness Is Now the Test Boards no longer ask whether the company is in the cloud. Instead, they ask whether it can use AI, and the honest answer usually depends on data.
Cloudera and Harvard Business Review Analytic Services published a data readiness report on March 5, 2026, after surveying more than 230 HBR audience members. Only 7% of the enterprises say their data is completely ready for AI. Another 27% say it is not very ready or not at all ready.
That gap changes what a cloud program is for. Moving data to the cloud does not make it ready by itself, whereas consolidating, governing and refreshing it does. So a plan that leaves data for phase three leaves AI for phase four.
AI Assessment
How Ready Is Your Data for AI?
Score your data, governance and AI maturity in a few minutes, and see which gaps your cloud plan should close first.

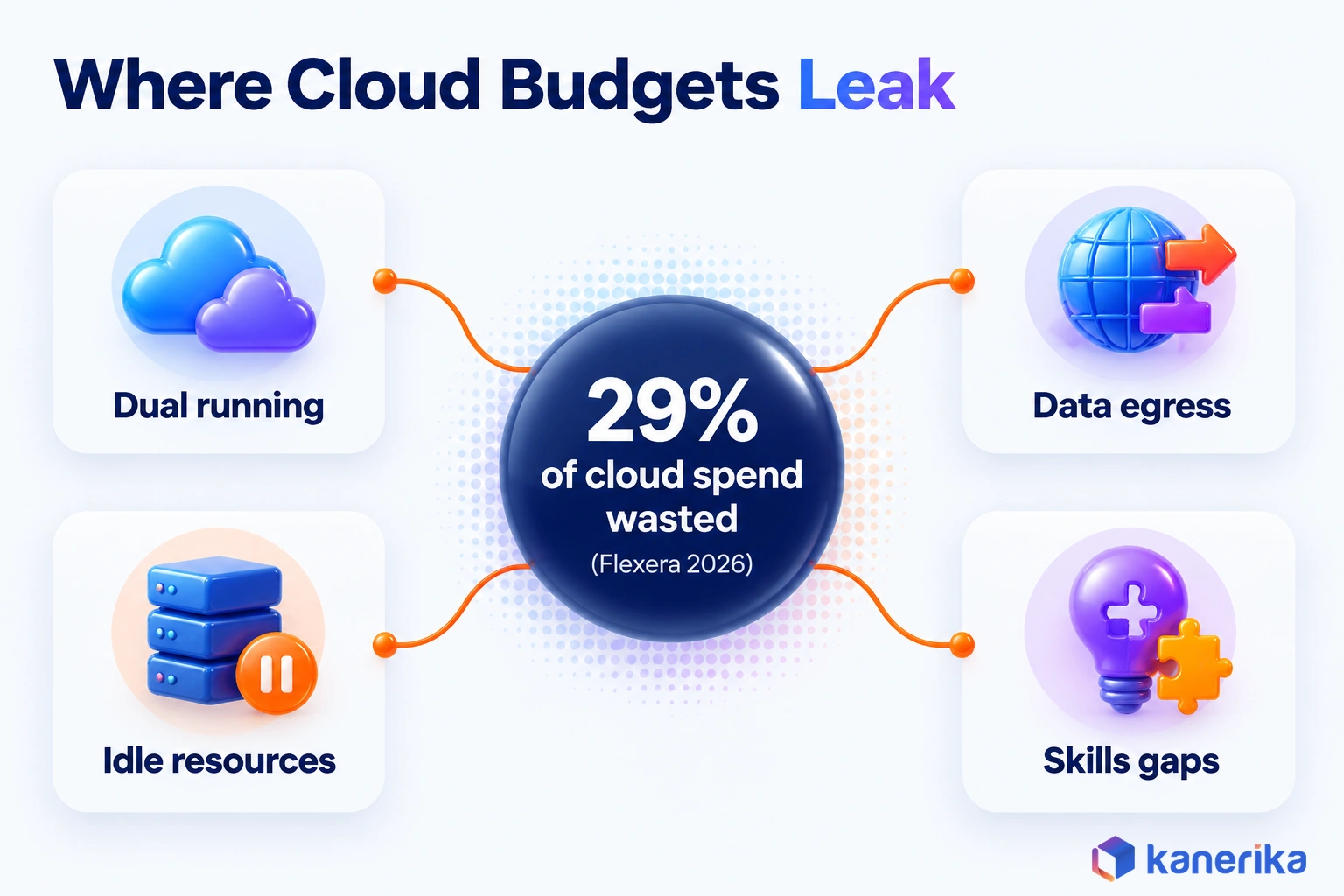

Start Your AI Assessment → Cloud Waste Is Rising Again Cost is the second pressure. Flexera’s 2026 State of the Cloud Report , its 15th annual survey with more than 750 respondents, estimates that 29% of cloud spend is wasted. That figure is the first increase in five years, and Flexera also ties it to AI workloads.
The same survey found that 85% of organizations name managing cloud spend as their top challenge. Waste of that size rarely comes from one bad decision. Instead, it builds up from oversized instances, forgotten test environments and data copied between regions while nobody owns the bill.
Security and Data Residency Shape the Architecture Cloud providers secure the infrastructure, but the customer still secures what it puts there. AWS describes the split as security “of” the cloud versus security “in” the cloud in its shared responsibility model .
In practice, identity, encryption settings, network rules and data classification stay your job after the move. Regulated workloads, such as health records under HIPAA or financial reporting controls under SOX, add rules about where data lives and who may see it. Those rules often decide the deployment model before any cost comparison does.

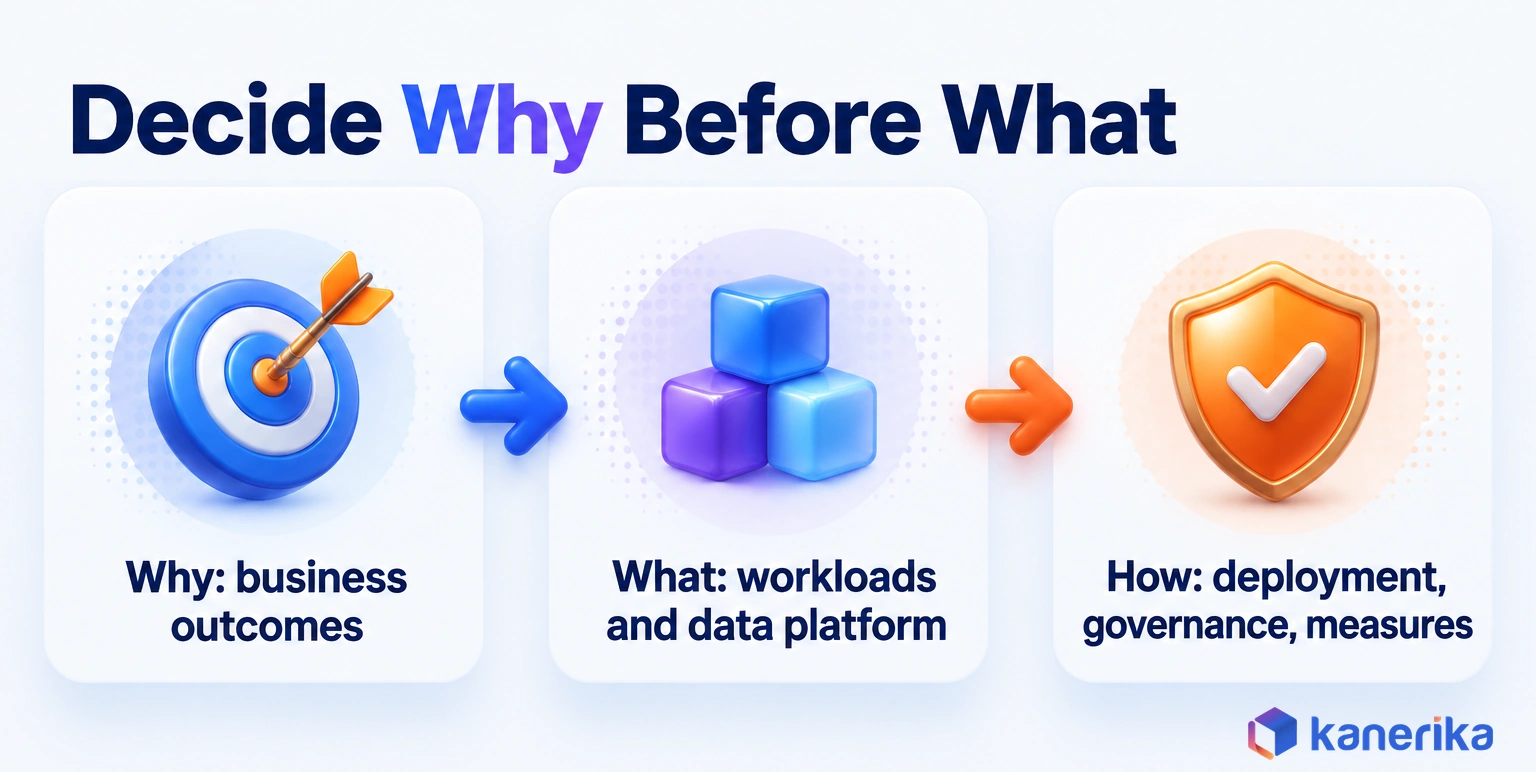

The Six Decisions Behind Every Cloud Transformation Strategy Every serious cloud program answers the same six questions, and each one needs a named owner and some evidence before it is closed.
Older guides list pillars such as security or cost. Pillars are useful, but they do not tell anyone what to decide or when. The six decisions below work as a sequence, so the order matters. Outcomes come first, because every later choice is judged against them, and ownership and measures close the loop.
Which Business Outcomes Must Improve? Start with two to four outcomes the business can measure today. For example, the goal might be a faster month-end close, a new digital channel, or governed customer data for an AI team. Each outcome also needs a baseline and a sponsor outside IT.
Outcomes keep the program honest. When someone later proposes refactoring a stable internal tool, the team can ask which outcome it serves, and if none, it waits. The executive sponsor owns this decision, while the evidence is a one-page outcome sheet with current numbers.
Which Workloads Move, Change or Stay? An inventory of applications and data stores is the raw material here. For each workload, record business value, technical health, dependencies, data sensitivity and license terms. That record then turns a vague list into a ranked backlog.
The 7 Rs, covered later in this guide, give each workload a disposition. Some move as they are, some change on the way, and others are retired or kept on-premises. Enterprise architecture usually owns the decision, although application owners sign off on their own systems.
Which Deployment Model Fits? The deployment model sets where workloads run and how much control you keep. Large organizations usually end up with a mix, chosen per workload rather than once for the whole company.
Model Best fit Main trade-off Public cloud Variable demand, new digital products, analytics at scale Least hardware control, so costs need active management Private cloud Strict data control and steady, predictable workloads Higher fixed cost and slower access to new services Hybrid cloud Regulated data kept on-premises with cloud analytics or front ends Two environments to secure, connect and operate Multi-cloud Best-of-breed services or risk spread across providers More skills, tooling and governance overhead
The infrastructure team proposes the model per workload, and security then confirms it against data rules. Kanerika’s guide to cloud architecture also covers the design patterns behind each model in more depth.
What Must the Target Data and AI Platform Support? This is where cloud transformation and AI strategy meet. The target platform has to hold the data the outcomes depend on, and it must serve reports and models from the same governed source. It also has to deliver data as fresh as the business needs.
Typical choices include a lakehouse on Microsoft Fabric or Databricks, or a cloud data warehouse such as Snowflake. The section on data and AI below covers which one fits whom. Teams weighing a cloud-first vs cloud-native approach face a similar question at the application layer. The data platform lead owns this choice, but only after a short proof of concept on real data. That test loads one outcome’s real data and measures freshness and cost per run.
Who Owns Governance and Daily Operations? Cloud makes provisioning easy, which is exactly why ownership has to be settled early. Someone must own identity policy, cost tagging, data classification and incident response before the first production workload lands.
Take a developer who spins up an untagged test database on a Friday afternoon. By Monday it has run all weekend, and nobody knows whose budget pays for it or who should have received the alert.
Bhupendra Chopra, Co-Founder and CRO at Kanerika, puts it plainly: “The governance model has to be designed before the first workload moves.”
In many organizations, a cloud center of excellence holds the standards, while product teams run their own services within them. The CIO or the CCoE lead owns this decision, and the evidence is a signed RACI before wave one. The CCoE table in the governance section below shows how that split usually works.
How Will You Know It Is Working? Pick the measures before migration starts, so the baseline is real. Good measures also connect to the outcomes from the first decision. For instance, track unit cost per transaction, availability, release frequency, data freshness and the share of spend tagged to an owner.
Then review them quarterly with the sponsor. If the measures have not moved after two or three waves, pause and correct course before the next wave.
Kanerika Service
Azure Cloud Solutions from Kanerika
Kanerika designs landing zones, migrates workloads and data, and runs cost and governance reviews on Azure, so every wave ties back to a business outcome.
Explore Azure Cloud Solutions How to Assess Cloud Readiness Before You Commit A readiness assessment tells you what you actually have, how it connects, and whether your people can run it in the cloud. It also replaces opinions with a backlog that has owners and evidence.
Skipping it is an easy way to overrun. For example, a team might estimate 200 applications, then find 340 during the first wave. It may also learn that payroll quietly depends on a file share nobody listed.
Applications and Dependencies Dependency mapping shows which applications talk to each other, and through which ports, databases and file shares. Without it, a team moves one system and then breaks three others that shared its database.
Discovery tools collect much of this automatically. Azure Migrate is Microsoft’s hub for discovery, assessment and migration to Azure, while AWS Transform supports migration and modernization work on AWS.
Kanerika’s roundup of Azure migration tools also compares the Microsoft options in detail. Tools still need interviews with application owners, because no scanner knows that a report runs only at quarter end.
Data Estate and Data Gravity Data gravity is the pull that large data sets exert on the applications around them. Applications tend to move toward their data, because shipping large volumes across networks is slow and incurs transfer fees.
So map where the biggest and busiest data sets sit before you sequence applications. Suppose, for example, that a 40 TB warehouse feeds twenty reports.
If the reports move first, they then read their data across a network link at higher latency and cost. Instead, move the warehouse first, or move it together with its main consumers in one wave.
Skills and Organizational Readiness Cloud changes daily work for infrastructure, security, finance and development teams. So assess who can operate managed services, write infrastructure as code and read a cloud bill. Then plan training or partner support for the gaps.
When AI is the main outcome, Kanerika’s AI Maturity Assessment gives a quick score for data, governance and AI readiness.
The table below turns these three areas, as well as security and finance, into questions you can answer with evidence.
Readiness area Questions to answer Evidence Applications Which applications exist, who owns them, and what do they depend on? Discovery scan plus owner interviews Data Where do large data sets sit, how sensitive are they, and who uses them? Data catalog extract and classification Security and compliance Which rules govern data location and access? Control mapping per regulation Skills Can teams run managed services and infrastructure as code? Skills matrix by role Finance Is the current cost of each workload known? Baseline cost model
A readiness review is only as good as the business analysis behind it. The technical scan says what exists, but only business owners can say which systems matter most and why.
Kanerika Service
Cloud Migration Services from Kanerika
Kanerika runs discovery, dependency mapping and readiness scoring, then plans each workload’s migration path and wave so the move serves the outcomes you set.
Explore Migration Services Choosing a Migration Approach for Each Workload: The 7 Rs The 7 Rs are a shared vocabulary for deciding what happens to each workload. AWS documents them in its prescriptive guidance on migration strategies , so architects and business owners work from the same set of options.

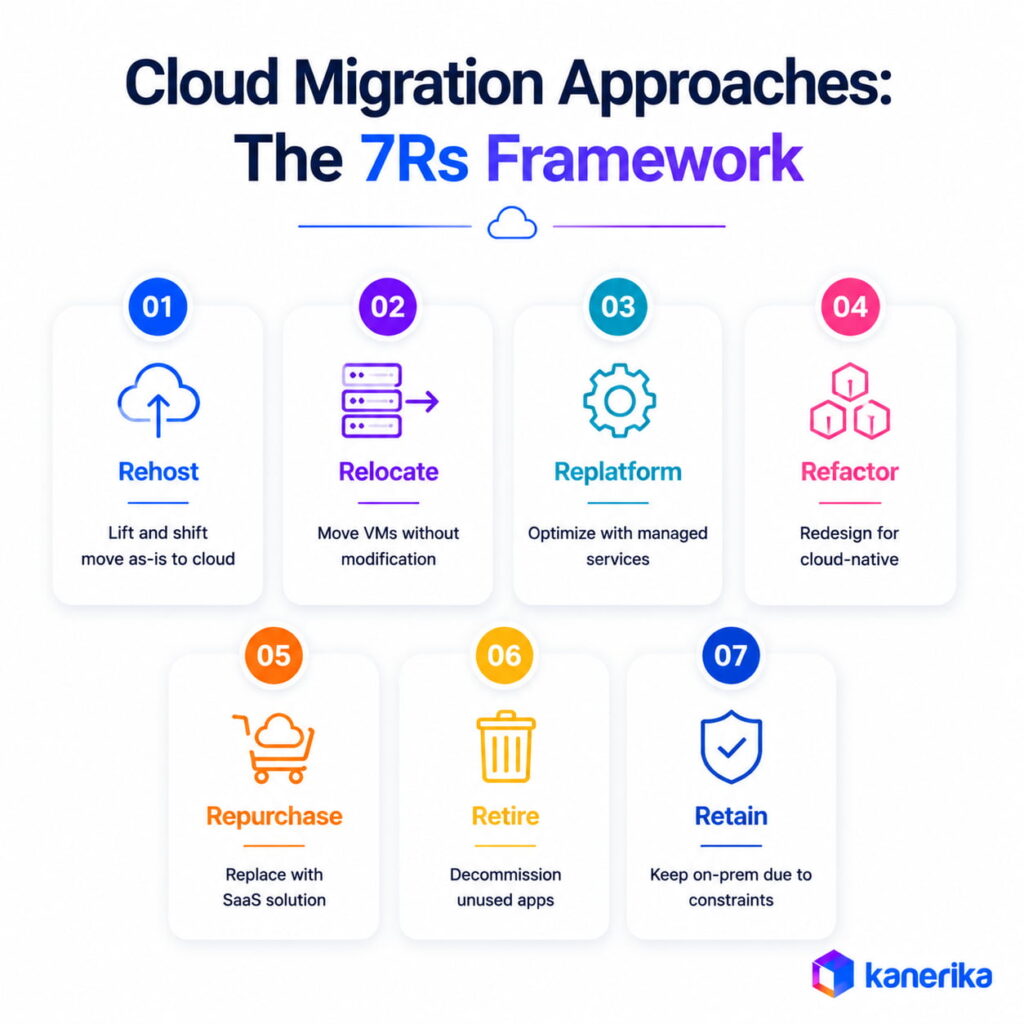

The Seven Options in Plain Terms Retire means switching off applications nobody needs, and every inventory finds some. Retain means keeping a workload where it is for now, especially when latency, licensing, compliance or a planned replacement holds it back. Rehost, often called lift and shift, moves a workload to cloud infrastructure with little or no change.
Relocate moves infrastructure in bulk, for example shifting a VMware estate to a cloud-hosted VMware service without converting each server. Repurchase replaces an application with a SaaS product, such as swapping an old CRM for a subscription CRM. Replatform makes targeted changes on the way, such as moving a self-managed database to a managed service.
Refactor, also called re-architect, redesigns the application around cloud-native services such as containers, serverless functions or event streaming. It costs the most effort, but it also returns the most flexibility.
How Microsoft’s Framework Compares Microsoft’s Cloud Adoption Framework uses a related list of eight options: retire, retain, rehost, replatform, refactor, rearchitect, rebuild and replace. The labels differ slightly, yet the logic is the same. In both, you decide per workload rather than once for the whole company.

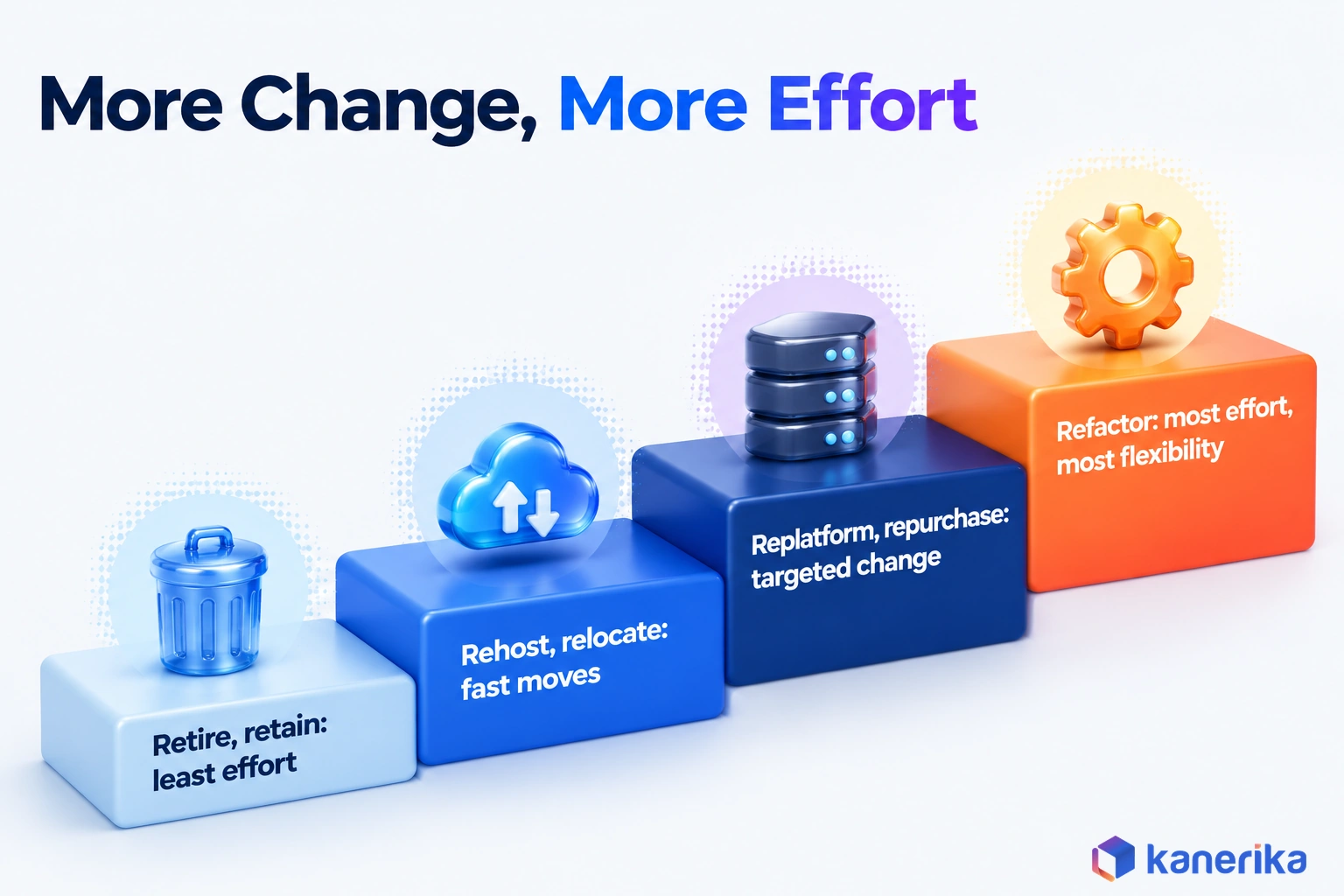

The table sets the seven AWS options side by side, from the lowest effort to the highest.
Approach When it fits Effort Example workload Retire Low use or a duplicated function Very low An old reporting tool replaced by a BI platform Retain Latency, compliance or license limits Very low A plant-floor control system Rehost Deadline-driven exit for a stable application Low A line-of-business app on Windows Server VMs Relocate Large virtualized estate that must exit fast Low A VMware cluster moved as a whole Repurchase A mature SaaS product covers the need Medium An on-premises CRM replaced by a SaaS CRM Replatform Clear gain from managed services Medium SQL Server moved to a managed database Refactor or re-architect Core application that needs scale or new features High A customer portal rebuilt on containers
When a Workload Should Stay Where It Is Keeping a system in place is a valid result in its own right. For instance, manufacturing control systems often need millisecond responses on the plant floor. Some software licenses also do not allow cloud hosting , or cost far more there.
Data residency rules can also hold specific data sets in one country or one facility. Retiring works the same way in reverse. An application with ten users and a modern replacement should be switched off rather than moved.
Each retired system then removes a migration task, a security review and a line from the future cloud bill. Systems that will stay on-premises still need a plan of their own, and data center modernization covers that side.

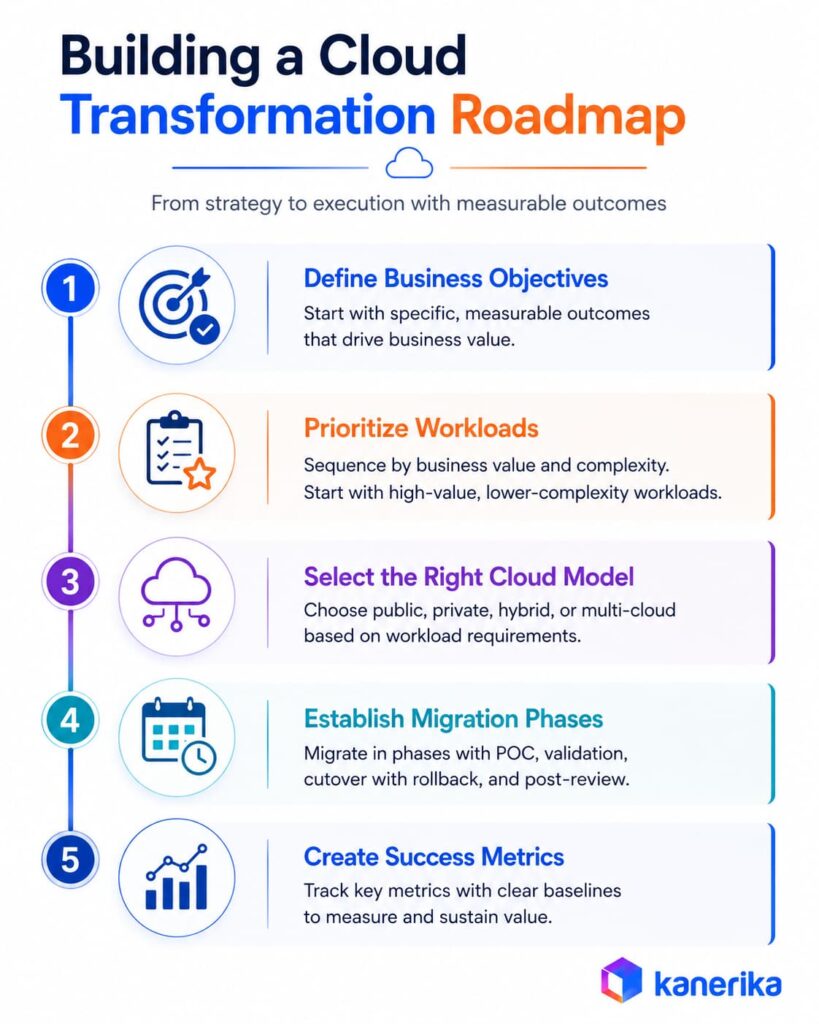

How to Build a Cloud Transformation Roadmap, Step by Step A roadmap turns the six decisions into a sequence of work. Each phase ends with an exit test that must pass before the next one starts. So a program cannot drift into the next wave with open problems.
Roadmap governance across many programs at once is a wider topic, which Kanerika’s guide to enterprise transformation covers. The six steps below stay with the cloud program itself.

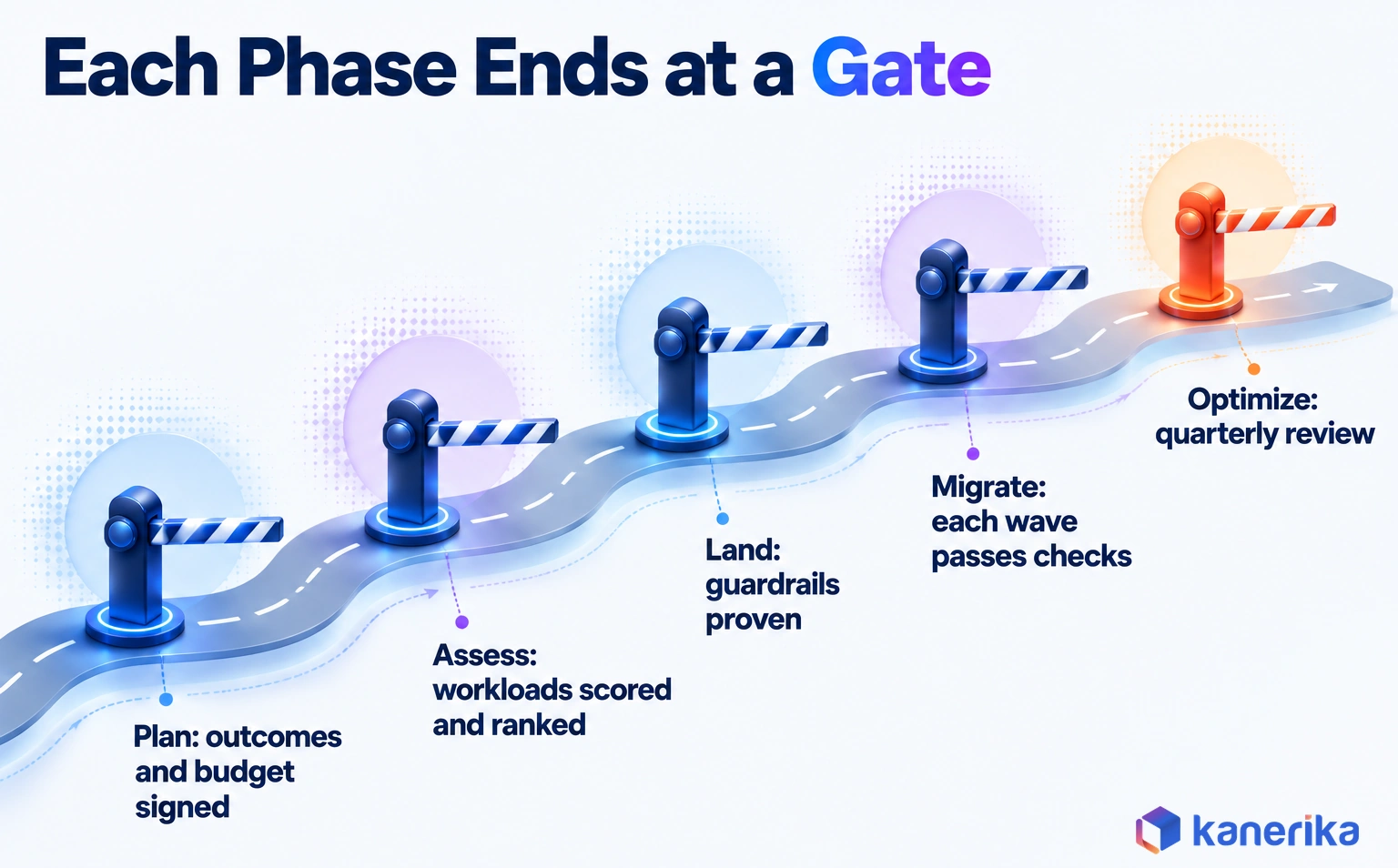

Six Steps, Each With an Exit Test Set priorities and investment limits. Agree on the outcomes, the budget range and the risk appetite. Exit test: a signed outcome sheet and funding for the first two waves.Assess the estate. Run discovery, map dependencies and classify data. Exit test: every in-scope workload has an owner and a complete profile.Prioritize workloads. Give each workload one of the 7 Rs and a wave. Exit test: a ranked backlog that business owners accept.Design the landing zone and governance. Build identity, networking, policies and cost tagging before workloads arrive. Exit test: guardrails proven on a pilot workload.Migrate in waves. Move related workloads together, test them, then cut over. Exit test: each wave passes functional, performance and data checks.Optimize and review quarterly. Right-size resources, retire leftovers and track the KPIs. Exit test: cost and performance measures reviewed with the sponsor every quarter.Where Roadmaps Usually Slip Step three is where the business case is won or lost, because it sets what the first waves prove.
Workloads are sequenced on two axes: the business value cloud migration delivers and the complexity of the migration. This operational shift makes it much easier to build, share, and update an interactive digital presentation safely in the cloud, keeping distributed teams perfectly aligned. High-value, lower-complexity workloads go first. They build momentum, develop team capability, and demonstrate ROI before the organization takes on harder migrations.
A typical first wave mixes a few internal web applications, a reporting database and a development environment. None of them carries the whole business, yet each one teaches the team something about the landing zone.
Step five is mostly discipline. Each wave follows the same pattern of freezing changes, moving the data, running parallel checks and cutting over. Keep a rollback path until the numbers reconcile, and use Kanerika’s data migration checklist for the detailed checks.
Step six never really ends. The quarterly review is where idle resources, oversized databases and stale copies get caught, before they compound across a year of invoices.
A Decision Framework for Common Scenarios Cloud programs rarely start from a blank page, since a trigger usually sets the timing. The table maps common triggers to a starting approach, so the first wave matches the reason the program exists.
Scenario Recommended starting approach Why Data center lease or hardware refresh due within 12 months Rehost or relocate first, then modernize in later waves Meets the date with the least change, so optimization follows later AI program blocked by scattered data Replatform the data estate to a governed lakehouse or warehouse first AI depends on consolidated, governed data more than on compute Regulated data with residency rules Hybrid: keep restricted data governed in place and move applications and analytics around it Meets location rules while gaining cloud scale for everything else Major license renewal for on-premises software Repurchase as SaaS or replatform before the renewal date Avoids paying for another full license term Rising cloud bill after an earlier lift and shift Optimize, then replatform the top cost drivers The waste sits in running workloads, not in new migrations Many teams already using cloud ad hoc Build a landing zone and governance first, then bring teams in Turns scattered adoption into a controlled platform
Rehosting is the right first move in only one of these rows. The others start with the data platform, licensing or governance, because that is where the trigger actually bites.
Worked Example: A Mid-Size Manufacturer Consider a hypothetical manufacturer with 120 applications, two plants and one data center whose lease ends in 18 months. Leadership wants two outcomes. The first is to exit the data center on time, while the second is a demand forecast built on clean sales and inventory data.
The assessment sorts the estate as shown below. Plant control systems stay put for latency reasons, and old reporting tools are switched off. Meanwhile, the ERP database moves to a managed service, and sales and inventory data lands on a governed lakehouse that feeds the forecasting model.
Disposition Workloads Examples Retire 18 Duplicate reporting tools and unused file shares Retain 12 Plant-floor control and quality systems Rehost 55 Internal web apps, file services and utilities Repurchase 10 HR, expense and CRM tools moved to SaaS Replatform 20 ERP database, and the data warehouse moved to a lakehouse Refactor 5 Customer order portal and the forecasting service Total 120 All in-scope applications
The lease deadline drives the rehost wave, but the forecasting outcome drives the replatform work. Without that second outcome, the company would have rehosted the warehouse too and repeated the retailer’s story from the opening.
Talk to Kanerika
Planning Your First Migration Waves?
Kanerika maps your estate to the 7 Rs, sequences the waves around your outcomes and flags the data work your AI plans depend on.
Talk to a Cloud Expert → Cloud Transformation Costs, FinOps and ROI Cloud turns technology cost from a hardware purchase every few years into a monthly bill that moves with usage. That flexibility helps, but only when someone watches it.
A business case built only on hardware savings therefore misses half the picture. It should count the cost of getting there and the cost of running in two places for a while. It should also count savings that only appear after optimization.
What Belongs in the Business Case Include each of these lines, even when the first estimate is rough. Otherwise, a sound program can end up looking over budget halfway through.
Migration labor: assessment, design, data movement, testing and cutover, whether staff or partners do the work.Dual running: the months when the old and new environments both cost money.Licenses: new SaaS and managed service fees, minus retired on-premises licenses and support contracts.Egress and data transfer: charges for moving data out of a cloud region or between providers.Training and new roles: cloud engineering, FinOps and security skills.Optimization: right-sizing, pricing commitments and cleanup after each wave.For benchmarks on how enterprises scope and fund these programs, Kanerika’s report The State of Enterprise Data Platform Migrations 2026 is a useful companion.
Running FinOps: Inform, Optimize, Operate FinOps is the practice that keeps cloud cost tied to business value. The FinOps Foundation defines it as an operational framework and cultural practice that maximizes the business value of technology, cloud included. It works by bringing engineering, finance and business teams together.
The work runs through three phases : Inform, Optimize and Operate. First, Inform gives every team visibility of what it spends and why. Then Optimize finds savings such as idle resources and better pricing commitments, and Operate builds those habits into daily work and governance.
Tagging is the foundation for all three phases. When every resource carries an owner and a cost center, Inform reports become accurate and teams see the cost of their own choices. Without tags, savings conversations stall on arguments about whose spend it is.
Flexera’s 2026 survey also found that 63% of organizations have established FinOps teams. For Azure estates, Kanerika’s guide to Azure cost optimization lists the specific levers.
KPIs to Review After Migration Choose a short list of measures and keep the definitions stable, so the trends mean something.
KPI How it is measured Review cadence Unit cost per workload Monthly cloud cost divided by a business driver such as orders or users Monthly Availability Uptime of critical services against agreed targets Monthly Deployment frequency Releases to production per team Quarterly Data freshness Time between a source change and its arrival in key reports Weekly for critical data Share of spend tagged Percentage of cloud cost assigned to an owner and cost center Monthly
Watch unit cost most closely. If it rises while business volume stays flat, the program has a waste problem, even when the total bill looks acceptable.
Migration ROI Calculator
Estimate Your Migration ROI
Put your own workload count, dual-running months and license changes into Kanerika’s migration ROI calculator before you finalize the business case.
Calculate Migration ROI → Governance, Security and the Cloud Operating Model Governance in the cloud means deciding who can create what, under which rules, and how anyone would know if a rule broke. It has to be designed for the cloud, because resources appear in minutes rather than months.
Policies written for a data center assume a ticket and a change board before anything new exists. In the cloud, though, a developer can create a database during a coffee break. So the rules have to live inside the platform as policies, templates and automated checks.
Shared Responsibility and Landing Zones The shared responsibility model sets the boundary. The provider secures the physical and core platform, while you secure identities, data, configurations and access. A landing zone is the pre-built environment that applies your side of that bargain by default.
A typical landing zone includes the account or subscription structure, identity integration, network layout, logging, policy guardrails and cost tagging. Teams then define it as code, which is where cloud automation tools for infrastructure as code and policy as code earn their place.
The Cloud Center of Excellence: Who Decides What A cloud center of excellence (CCoE) is a small cross-functional team that sets standards and helps product teams adopt them. It should enable teams rather than approve every request.
The split below is a simple starting point. Adjust the names to your organization, but keep one clear owner per row.
Decision CCoE Product teams Security Finance Landing zone and guardrails Owns Consulted Approves Informed Workload migration plan Advises Owns Consulted Informed Identity and access policy Consulted Follows Owns Informed Cost tagging and budgets Sets the standard Applies tags Informed Owns reporting Data classification Consulted Applies labels Approves Informed

Where Data and AI Fit in the Strategy Data and AI are the reason many cloud programs get funded, so the data platform deserves its own place in the plan. It should never be a single line inside a migration wave.
AI readiness is a data infrastructure question. Models require clean, consolidated, well-governed data that moves through reliable pipelines, and those same pipelines need AI security controls covering model access, data exposure, and the new attack surface that inference workloads introduce. The compute infrastructure running inference workloads has to scale under variable load without requiring dedicated hardware provisioned for peak capacity. Organizations that build agentic AI systems find that cloud infrastructure is a prerequisite, not an option.
The platform choice then follows from the outcomes. Microsoft Fabric often suits organizations standardized on Microsoft 365, Power BI and Azure. Databricks tends to fit teams with heavy data engineering and machine learning work, while Snowflake suits SQL-centered analytics shared across business units.
Real-time needs matter too. A fraud check or a plant sensor alert needs streaming data within seconds, whereas a monthly board report does not. So design for the freshness each outcome actually needs, because always-on streaming costs more than scheduled batches.
Kanerika’s overview of cloud analytics also covers the reporting side of this choice. For survey data on how enterprises pair modernization with AI, see The State of Enterprise AI and Data Modernization 2026 .
Common Cloud Transformation Mistakes and How to Avoid Them The mistakes below show up across industries, and each one has an early symptom you can spot before it gets expensive. None of them is technical in the narrow sense, though.
Instead, they come from skipped decisions, which is why the earlier sections matter. Kanerika’s guide to data migration risks also goes deeper on the data side.
Mistake Early symptom Prevention Lift and shift everything Cloud bill above the old data center cost Assign one of the 7 Rs per workload and plan replatform waves No outcome or baseline Nobody can say whether the program worked An outcome sheet with current numbers before wave one Governance after migration Untagged resources, open storage and surprise invoices Landing zone and policies before the first workload Data left for later AI and analytics teams still copy data by hand Put the data platform in the first two waves Skipping dependency mapping Outages after cutover in systems nobody touched Discovery tools plus owner interviews Underestimating dual running The budget runs out mid-program Model the overlap months in the business case No FinOps owner Waste grows quarter over quarter A named FinOps lead and monthly reviews
Nearly all of these share one root cause. The program was planned as a move rather than a change, so nobody owned the change.
How Kanerika Delivers Cloud Transformation Kanerika runs cloud and data platform programs in five stages: assess, design, validate, migrate and optimize. Each stage ends with evidence the client signs off, so the work stays tied to the outcomes set at the start.
Assessment maps applications, data and dependencies, then scores readiness. Design sets the target data platform, landing zone and governance model.
Validation proves the design on a real workload before scaling, and migration then moves the estate in waves with automated checks. Finally, optimization tunes cost and performance once workloads are live.
For data platform moves, Kanerika’s FLIP migration accelerator automates much of the pipeline conversion, and Kanerika reports 80% faster pipeline deployment with it. In December 2025, Kanerika also earned the Data Warehouse Migration to Microsoft Azure specialization . Delivery runs through Kanerika’s cloud migration services and Azure cloud solutions , with Microsoft Fabric as a common target for analytics and AI.
Case Study: 80% Faster Insights After Moving Azure Data Factory to Microsoft Fabric Challenge. A global leader in packaging solutions ran its data workflows across Azure Data Factory and Synapse. The scattered setup caused latency and pipeline failures, so reporting lagged behind the business.
Solution. Kanerika migrated the workflows to Microsoft Fabric with minimal downtime, bringing ingestion, transformation and reporting onto one platform. In 7 Rs terms this was a replatform, and picking Fabric as the target was decision four, the data and AI platform, in practice.
Results. The client cut cloud and data costs by 30%, improved its data pipeline by 50%, and got business insights and reporting 80% faster. The full Azure Data Factory to Microsoft Fabric case study has the details.
Case Study
80% Faster Insights with Azure to Microsoft Fabric
A global packaging leader moved scattered Azure Data Factory and Synapse workflows to Microsoft Fabric, cutting cloud and data costs by 30% and speeding insights and reporting by 80%.
Read the Case Study → Final Verdict: What to Decide This Quarter A cloud transformation strategy is judged by the business outcomes and data readiness it delivers. Four decisions belong on this quarter’s agenda.
First, write down two to four outcomes with baselines and a named sponsor. Second, fund a discovery and dependency assessment so the backlog reflects reality. Third, choose the target data platform, because every AI plan depends on it. Finally, stand up the landing zone, cost tagging and a FinOps owner before wave one.
So how do you build a cloud transformation strategy that works? Make the six decisions in order and give every workload one of the 7 Rs. Then run the roadmap in phases with exit tests, and treat AI-ready data as the test of success.
Frequently Asked Questions
What is a cloud transformation strategy? A cloud transformation strategy is a business plan for changing how an organization builds, runs and pays for technology using cloud services. It decides which workloads move, change, stay or retire, which deployment model fits, and how the program is funded, governed and measured. Its success is judged by business outcomes and AI-ready data, not by servers moved.
How is cloud transformation different from cloud migration? Cloud migration moves workloads and data from on-premises infrastructure to a cloud provider, often with little design change. Cloud transformation is broader. It changes the operating model, funding, governance and data use so the business gains something measurable, such as faster reporting or AI readiness. A migration can finish on time while the transformation has barely started.
How does cloud transformation support AI adoption? AI needs clean, consolidated and governed data delivered through reliable pipelines, plus compute that scales with demand. A cloud transformation that puts the data platform in its early waves creates that foundation. It matters because only 7% of enterprises say their data is completely ready for AI, according to Cloudera and Harvard Business Review Analytic Services.
Should a business choose public, private, hybrid or multi-cloud? Large organizations usually end up with a mix chosen per workload. Public cloud suits variable demand and analytics at scale. Private cloud fits strict control and steady workloads. Hybrid keeps regulated data in place while using cloud analytics, and multi-cloud spreads risk or adds best-of-breed services at the cost of more skills and governance work.
How do you measure cloud transformation success? Measure against the outcomes and baselines set before migration began. Useful KPIs include unit cost per workload, availability of critical services, deployment frequency, data freshness for key reports, and the share of cloud spend tagged to an owner. Review them monthly or quarterly with the business sponsor, and adjust the roadmap whenever they stall.
What is the difference between cloud transformation and digital transformation? Digital transformation is the wider effort to change products, customer experience and operations with technology. Cloud transformation is one part of it, focused on how the organization uses cloud services, data platforms and operating models. A good cloud plan serves the digital goals by giving them scalable infrastructure, governed data and faster delivery of new services.
What is cloud adoption and how does it relate to cloud transformation? Cloud adoption is the growing use of cloud services across an organization, often team by team through SaaS tools, cloud databases and developer accounts. Cloud transformation turns that scattered adoption into a deliberate program with shared outcomes, governance, a landing zone and cost ownership, so cloud use supports business goals instead of multiplying risk.
What are the main components of a cloud transformation strategy? A strong strategy rests on six decisions. These are the business outcomes that must improve, which workloads move or stay, the deployment model, the target data and AI platform, who owns governance and operations, and how success is measured. Each decision needs a named owner and evidence, and outcomes come first because every later choice depends on them.
What is the biggest risk in cloud transformation? The biggest risk is moving systems without deciding what the move is for. Programs that lift and shift everything often end up with higher bills and the same data silos they had before. Setting outcomes and baselines, mapping dependencies, and putting governance in place before the first workload moves removes most of that risk while changes are still cheap.
How do organizations assess cloud readiness? They assess five areas. Applications are inventoried with discovery tools and owner interviews to map dependencies. Data is classified by size, sensitivity and use. Security rules are mapped to each regulation, team skills are scored by role, and the current cost of each workload is baselined. The result is a ranked backlog with clear owners and supporting evidence.
What is FinOps and why does it matter for cloud transformation? FinOps is an operational framework and cultural practice that maximizes the business value of technology by bringing engineering, finance and business teams together. Its three phases are Inform, Optimize and Operate. It matters because cloud cost moves with usage every month, and Flexera’s 2026 survey estimates that 29% of cloud spend is wasted, a figure FinOps teams work to reduce.
How long does a cloud transformation take? There is no standard duration. Timing depends on how many workloads are in scope, how many dependencies they share, and which of the 7 Rs each one gets. Rehosting moves quickly, while refactoring takes far longer. Programs usually run in waves, so plan the first two waves in detail and review the rest of the roadmap every quarter.
What best practices determine cloud transformation success? Successful programs set two to four measurable outcomes before any migration starts. They map dependencies, build a governed landing zone first, and give every workload its own migration approach. They also put the data platform in the early waves, name a FinOps owner, and review unit cost, availability and data freshness with the business sponsor every quarter.
What are the 7 Rs of cloud migration? The 7 Rs are retire, retain, rehost, relocate, repurchase, replatform and refactor, as described in AWS prescriptive guidance. They give each workload its own path, from switching it off or keeping it on-premises to redesigning it around cloud-native services. Microsoft’s Cloud Adoption Framework uses a related list of eight options that includes rebuild and replace.
How much does cloud transformation cost? Cost depends on scope, so a credible estimate is built from components rather than a single figure. Include migration labor, months of dual running, new license and service fees, data egress and transfer charges, training, and ongoing optimization. Then subtract retired hardware, licenses and support. Unit cost per workload is the best way to track spending afterward.
