TL;DR
Enterprise transformation roadmaps go wrong when launch dates become the goal and nobody tracks business results. Many also leave data cleanup for later and treat change management as a training course. The fix is a five-stage roadmap: assess, design, pilot, scale and sustain. Each stage must show measured results before the next one begins. A single broken process needs a small pilot first, while company-wide change needs clean shared data first. In both cases, a named business owner stays accountable after launch, when the benefits arrive.
Key Takeaways
Enterprise transformation changes strategy, operating model, processes, data and people together, so every change serves shared business outcomes.
Roadmaps stall when go-live dates replace business outcomes as the measure of progress.
Unmapped dependencies, a late data foundation and training-only change plans also cause many of the delays.
A five-stage roadmap (assess, design, pilot, scale, sustain) with exit gates stops a program from scaling what it has not proven.
A weighted scoring model and a four-part KPI scorecard keep priorities and progress visible to everyone.
Value owners stay accountable after go-live, because that is when the benefits show up.
Watch on YouTube
Enterprise Digital Transformation Roadmap: From Data Foundations to Agentic AI
A roadmap walkthrough that starts from the data foundation and builds toward agentic AI, the same order of work this guide recommends.
The ERP Went Live. Month-End Close Still Takes Twelve Days.
Picture a manufacturer two years into a transformation program. The new ERP went live on schedule, the cloud migration closed on budget and the steering committee marked every milestone green.
Then the CFO asks a simple question at the quarterly review. Why does month-end close still take twelve days?
Nobody in the room owns the answer. The ERP team delivered the system it was asked to build, while finance still reconciles in spreadsheets. The chart of accounts was never harmonized across the acquired plants, and that cleanup sits in phase three. Phase three has not started.
Every workstream hit its plan, but the enterprise still works the way it did before. That gap is the subject of this guide.
Green milestones over an unchanged business are a common way for an enterprise transformation roadmap to go wrong, and the pattern can be fixed.
What Is Enterprise Transformation?
Enterprise transformation is a coordinated change to how a whole organization operates, makes decisions and measures value. It touches strategy, structure, processes, data and the daily work of thousands of people at the same time.
The word that matters is coordinated. A company can replace its CRM, open a shared-services center and launch an AI pilot in the same quarter without transforming anything. Those are three projects. They become one enterprise transformation only when a single plan connects them to a shared outcome, such as a faster order-to-cash cycle.
Scope is the second test. A transformation changes how work flows across functions, so finance, operations, sales and IT all feel it. A change that stays inside one department is usually a process improvement, which is useful work and far easier to run.
Enterprise vs Digital vs Business Transformation
The three terms overlap, so many teams use them as synonyms. The table separates them by scope, owner and how success is judged. If your program is mainly about adopting new technology, our guide to digital transformation strategy covers that angle in depth.
Type Scope Typical owner Unit of change Success measure
Enterprise transformation The whole operating model, across functions CEO or COO, supported by a transformation office Value streams, decision rights and the operating model Enterprise outcomes, such as cost-to-serve, cycle time and growth
Digital transformation Technology, data and digital channels CIO or CDO Platforms, applications and integrations Adoption, digital revenue and platform performance
Business transformation One business unit, business model or major function Business unit leader Products, processes or the business model Unit profit and loss, as well as customer metrics

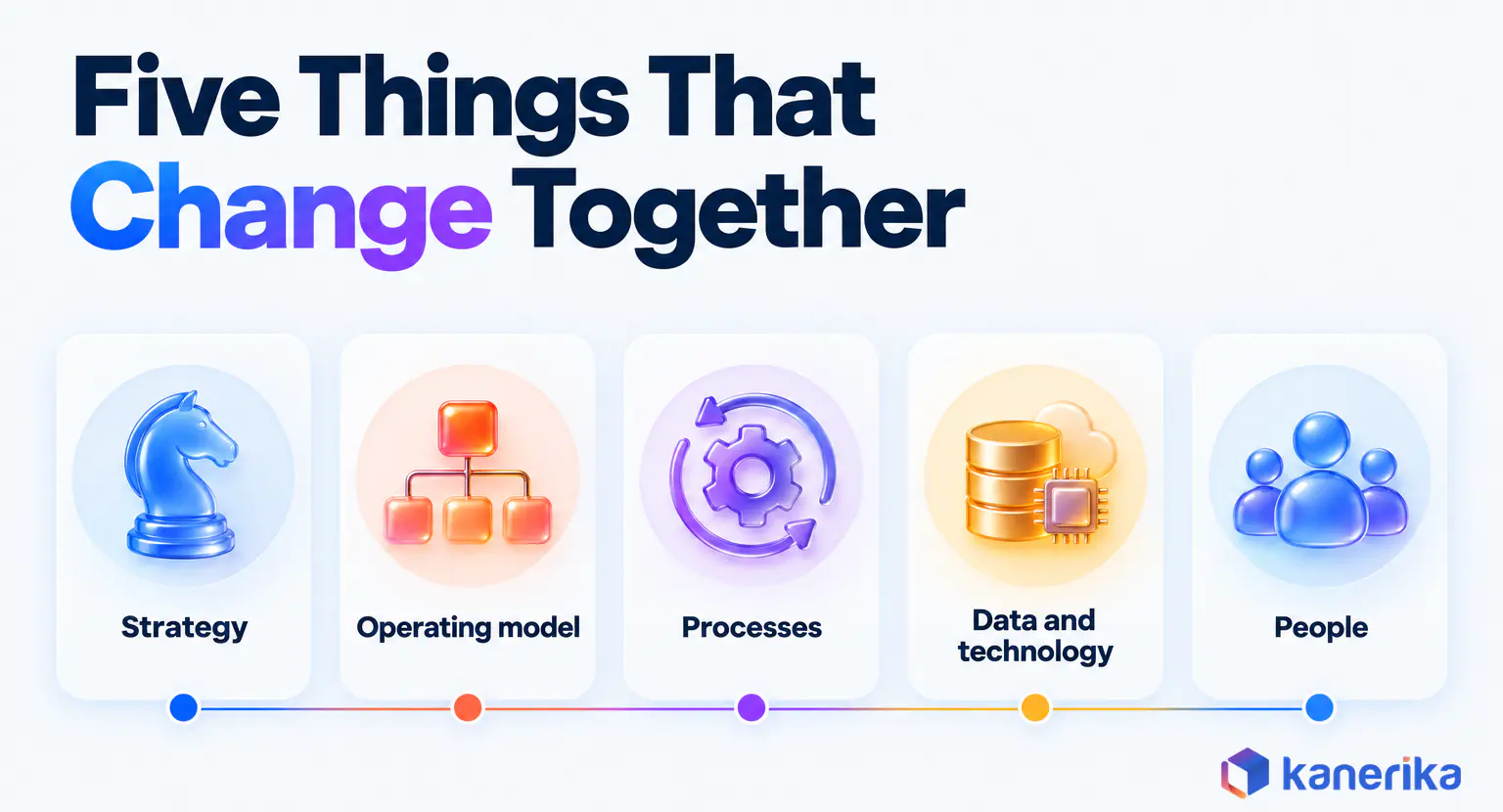

The Five Things That Change Together
An enterprise program moves five dimensions at the same time. When one of them lags, the others stall around it, just as the twelve-day close stalled on unharmonized finance data.
Strategy: the outcomes the enterprise commits to, and the order in which it pursues them.
Operating model: who decides, who owns each value stream and how teams are organized.
Processes: the end-to-end flows, such as order to cash or procure to pay.
Data and technology: the platforms, integrations and shared data that the new processes run on.
People: skills, roles and incentives, together with the habits that make a new way of working stick.
Treat the five as one system. A new process paired with old incentives drifts back to the old way, while a new platform fed with untrusted data simply gets bypassed.
What a Successful Transformation Delivers
A successful program shows up in a handful of plain business results. The manufacturer from the opening makes each one concrete.
Decisions get faster first. Before, each acquired plant closes on its own chart of accounts and finance spends twelve days reconciling them. After, finance works from one harmonized chart of accounts, and the target is a close in five days.
Cost-to-serve falls next, because duplicate work disappears. A plant controller who once keyed the same intercompany invoice into two ledgers posts it once after the change, and the reconciliation spreadsheet goes away. Rule-based steps that remain, such as invoice matching, are a natural fit for RPA in finance .
Customers notice it too. Before, an order was re-keyed between the plant system and the ERP, so a delivery question bounced between teams. After, the order moves through one flow, and the first person who picks up the question can answer it.
These results only count when they are measured against a baseline. For that reason, the roadmap later in this guide takes one before any build starts.
Why Enterprise Transformation Is Harder in 2026
Three pressures make a 2026 program harder to run than the ERP-led programs of a decade ago. Each one changes what a roadmap has to plan for.
The first is that AI is moving from pilots into core workflows. A pilot can live in a sandbox, but an AI step inside order management or claims handling needs trusted data, clear ownership and monitoring. A February 2025 Gartner press release predicted that organizations will abandon 60% of AI projects unsupported by AI-ready data through 2026.
Several programs also compete for the same people. A cloud migration, an ERP upgrade, a data platform build and an AI initiative often draw on one small group of architects and process owners. Without a portfolio view, each program plans as if those people were free.
Since NIST released CSF 2.0 in February 2024, risk frameworks shape design from the start. The Govern function in Cybersecurity Framework 2.0 makes cyber-risk ownership a design-stage decision, so the roadmap has to name that owner early. AI governance rules are still moving as well, since NIST is revising its AI Risk Management Framework , and the plan needs room to absorb changes.
A roadmap drawn up without these frameworks in view tends to meet them late, as audit findings that reopen work the program had already closed. Our guide to AI governance shows how to build those checks in from the first design stage.
The first pressure, AI moving into core workflows, is the theme of a Kanerika podcast episode, “What Are the AI Trends and Predictions for 2026?” It is a useful listen when you judge how soon your own roadmap must plan for AI in live processes.
What Most Enterprise Transformation Roadmaps Get Wrong

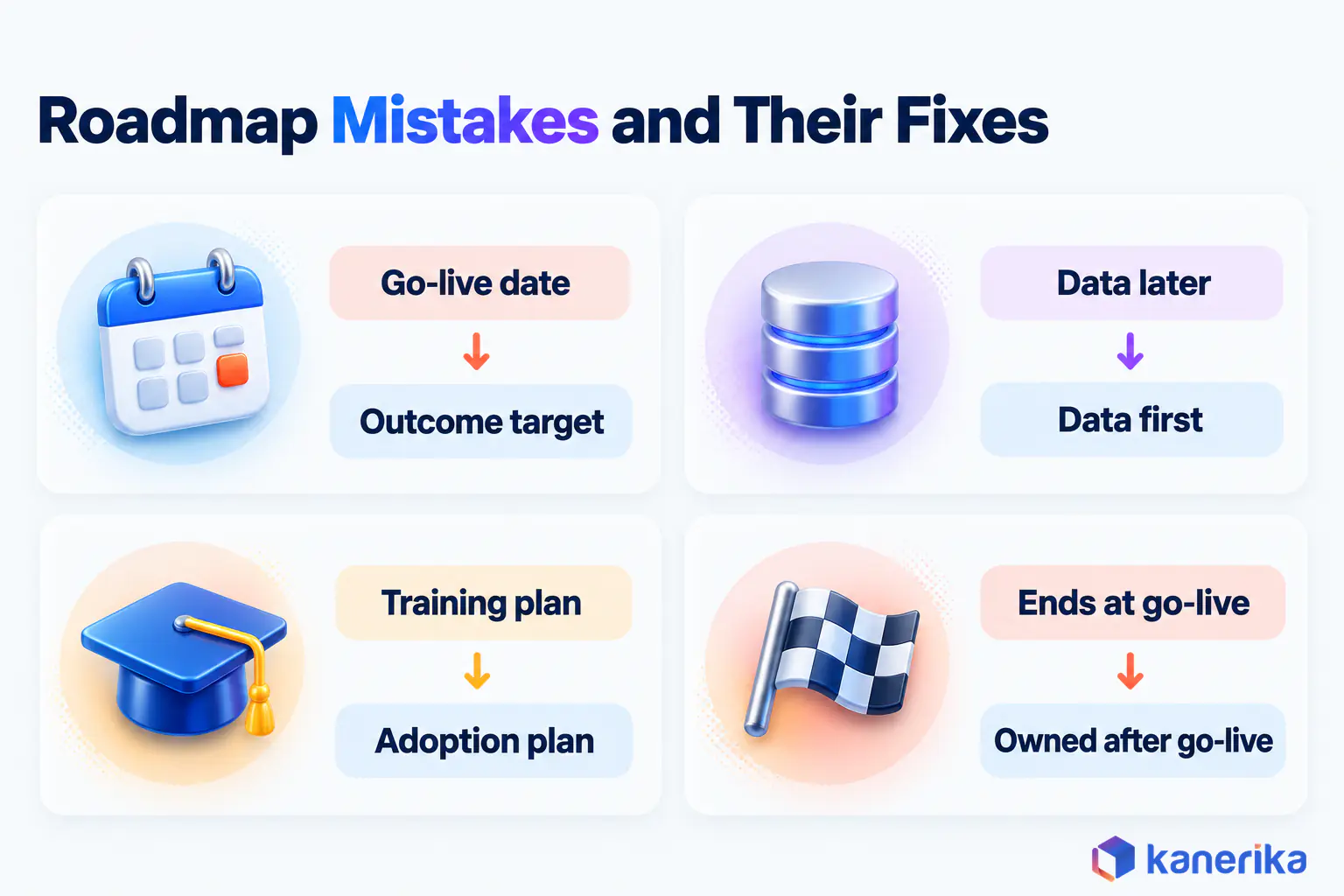

A roadmap usually starts failing long before anyone calls the program a failure. The warning signs are visible in the plan itself, once you know where to look.
Six mistakes come up again and again in large programs. Each row below names the mistake and the early sign that it is happening, together with the fix that a stage-gated roadmap builds in.
Mistake Early warning sign Fix
Technology milestones stand in for outcomes Status reports list go-lives but no business KPI Pair every milestone with an outcome and a baseline
Cross-functional dependencies are never mapped Blockers first appear during integration testing Build a dependency map before delivery starts
The data foundation is a later phase Each workstream builds its own extracts and reports Fund shared data domains before scaling
Change management shrinks to training Training completion is the only adoption measure Plan role changes and incentives, as well as adoption KPIs
Accountability ends at go-live The program team disbands before benefits appear Name a value owner who stays after go-live
Too many programs run at once The same experts are booked on three programs Run one portfolio view with capacity limits
Technology Milestones Stand In for Business Outcomes
Go-live dates are easy to track, so roadmaps fill up with them. The ERP cutover, the data migration and the new CRM each get a date and a red, amber or green status. Business outcomes are harder to measure, so they drift into an appendix.
The result looks like the twelve-day close. Every milestone was met, but no milestone said “close the books in five days.” Nobody could see the outcome slipping, because nobody was measuring it.
The fix is to write each milestone as a pair, the technical deliverable plus the business result it should move. Before delivery starts, record the baseline, such as days to close, order cycle time or cost per invoice. Then report the milestone as complete only after that number moves.
Cross-Functional Dependencies Are Never Mapped
Large programs are planned by workstream, and each workstream plan looks sound on its own. The trouble sits between them.
For example, sales might want a new pricing engine in March, while the product master it needs is scheduled for August. These collisions usually surface in integration testing, when fixing them is slow and expensive. Teams then add workarounds, such as a temporary spreadsheet feed in place of proper data integration , that quietly become permanent.
A dependency map prevents this. During design, list every initiative, the shared data and systems it needs and the teams it relies on. After that, sequence the work by those dependencies, and let the map settle disputes between sponsors.
The Data Foundation Is Scheduled as a Later Phase
Data cleanup feels like back-office work, so roadmaps often push it to phase three. Each workstream then builds its own extracts and reports to get by in the meantime.
At Kanerika, this is the failure we see most often in analytics and enterprise data migration work. The new ERP, the CRM and the planning tool each hold a slightly different customer list. Reports disagree, so leaders stop trusting them and finance goes back to spreadsheets.
Treat shared data as the first deliverable of the program instead. Agree on the few master data domains that most initiatives depend on, such as customer, product and chart of accounts. Then fund their cleanup, ownership and quality rules before the first wave of scaling.
Kanerika Service
Data Strategy Consulting
Kanerika assesses your data estate, sets ownership and quality rules for shared domains and plans the data foundation your roadmap depends on.
Explore Data Strategy
Change Management Shrinks to a Training Plan
Change management often gets reduced to a training calendar and a communications plan. Both help, though neither changes how a planner, a buyer or an account manager actually spends the day.
People adopt a new way of working when their role, targets and tools all point the same way. If a sales team is still paid on order volume, it will work around a new margin-based pricing process, however good the training was.
A better plan changes roles and incentives alongside the system design. Track adoption with real usage measures, such as the share of orders entered through the new process or the number of manual overrides. Training completion is an input, so it should never be reported as adoption.
Accountability Ends at Go-Live
Program teams are funded to deliver, so they disband once the system is live. The benefits arrive months later, after people settle into the new process, and by then nobody is left to chase them.
This is how a program can close on time and on budget while its business case goes unrealized. The steering committee approved the benefits, but nobody in operations agreed to own them.
Name a value owner for each stream before delivery starts. That person sits in the business, owns the KPI and stays accountable for at least two quarters after go-live.
Too Many Programs Run at Once With No Portfolio View
Enterprises rarely run just one transformation. A cloud program, an ERP upgrade and two AI initiatives may all be live at the same time, each with its own steering group.
Each program looks affordable in isolation. Together, though, they book the same data architects, process owners and frontline testers. Work then slows everywhere at once, and every program reports amber for the same hidden reason.
What works is one portfolio view across all programs, reviewed every month. It shows shared dependencies, people capacity and the value each initiative is expected to return. When capacity runs short, the review pauses the lowest-scoring initiative so that the others keep their experts. The scoring model later in this guide gives that review a consistent basis.
Which Transformation Approach Fits Your Situation?
Choosing an approach is really a scope decision, and getting it right prevents several of the mistakes above. Four approaches cover most situations.
Four Approaches Compared
A targeted process fix suits a single broken flow, such as slow supplier onboarding. A value-stream-led program redesigns one end-to-end stream, for instance order to cash, across every function it touches. An operating-model redesign goes further, since it changes structure, decision rights and how the whole enterprise is governed.
Some capability gaps are too wide to close from inside. When the enterprise needs technology, talent or market access that would take years to build, acquiring it can be faster. Stage 1 of the roadmap below shows where that option enters the plan.
Approach When it fits Scope Typical horizon Main risk
Targeted process fix One process is slow, costly or error-prone One process, one or two functions Months Fixes a symptom while the root cause sits elsewhere
Value-stream-led One end-to-end stream drives most of the cost or customer pain One stream, across every function it touches Several quarters Handoffs into streams outside the scope
Operating-model redesign Structure and decision rights block growth The whole enterprise Multiple years, delivered in waves Too much change at once, and change fatigue
Inorganic (acquire capability) The gap would take years to close in-house A target company plus its integration The deal timeline plus integration Integration absorbs the people the roadmap needs
When a Large-Scale Program Is Justified
A large-scale program is justified when the problem genuinely crosses the operating model. Typical signs include decisions that stall between functions, duplicated systems after acquisitions and a cost base that no single process fix can move.
The manufacturer from the opening shows two of them. Its acquired plants still run unharmonized charts of accounts, which is a case of duplicated systems after acquisitions. The close also stalls between plant finance and group finance.
With two signs present, the manufacturer would start value-stream-led on record to report, while an operating-model target guides the later streams. In other words, the first stream proves the approach, while the target model guides every stream that follows.

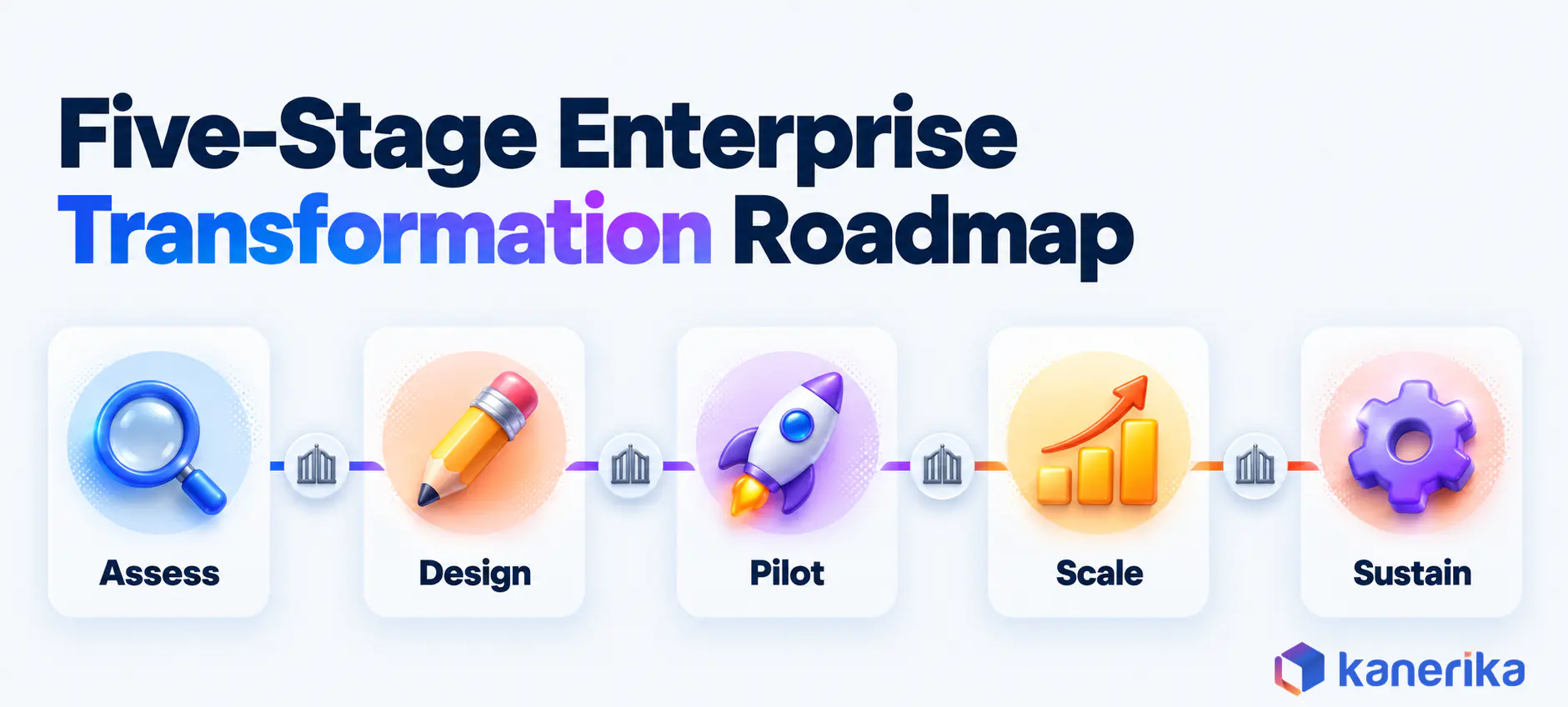

How to Build an Enterprise Transformation Roadmap That Delivers Results
A good roadmap is a sequence of decisions, and each decision is protected by an exit gate. The five stages below stop a program from scaling anything that has not yet proven its value.
Each stage ends with a gate review. The sponsor and the value owners check the evidence, then decide to proceed, adjust or stop. A program that passes every gate has proof at each step, so the next funding request becomes far easier to win.
Stage 1: Assess Outcomes, Baselines and Readiness
Start by naming the three to five outcomes the enterprise needs, written as measurable targets. Then take a baseline for each one, such as days to close or cost per order, before any build begins.
Readiness is the other half of the assessment. Check data quality in the domains your outcomes depend on, especially master data, where data observability tools can measure freshness and completeness. Then check the capacity of core teams and the programs already in flight.
Of course, you cannot change it all in one go. Take the most important and conduct a thorough internal analysis to understand your current capabilities. When the gap between your current capabilities and your desired future state is too wide to bridge organically, m&a consulting can help identify acquisition targets that close that gap faster. This is especially relevant for enterprises looking to add technology, talent, or market access that would take years to develop in-house.
Exit gate: approved outcome targets, signed-off baselines and a readiness score for data, people and technology.
Stage 2: Design the Target Operating Model and Sequence by Dependency
Design describes how the enterprise will work once the change lands. It covers decision rights, value-stream ownership, future processes and the data and platforms they need. On the platform side, a cloud transformation strategy sets out how infrastructure and applications should move.
Next, build the dependency map and sequence the initiatives by it. Shared data domains and integration layers usually come first, because several later initiatives rely on them. A governed data ingestion layer is often the first piece to build.
Exit gate: a target operating model, a dependency map and a sequenced backlog scored with the model in the next section.
Stage 3: Pilot One High-Value Process End to End
Pick one process that serves an outcome target and run it end to end in the new way. Keep the pilot narrow enough to finish in weeks, but real enough to use production data and real users.
A food and pharma manufacturer took this route with a four-week proof of value on Microsoft Fabric , covered in the Kanerika case study later in this guide.
Exit gate: the pilot moved its KPI against the baseline, and the team has a costed plan to scale it.
Case Study
Streamlining Data Operations and Reporting with Microsoft Fabric
A food and pharma manufacturer ran a four-week proof of value that consolidated data from six business platforms into one governed Fabric layer, so leadership had effort estimates before scaling.
Read the Case Study →
Stage 4: Scale in Waves
Scale the proven pattern in waves, one business unit or region at a time. Each wave reuses the data foundation, process design and training from the pilot, so later waves run faster. When that foundation sits in a cloud data warehouse , each new region plugs into the same models instead of rebuilding them.
Keep each wave small enough that the same experts are not stretched across all of them. Before a wave starts, review the portfolio view, and hold the wave back if its dependencies are not ready.
Exit gate: each wave meets its KPI and adoption targets before the next one launches.
Stage 5: Sustain Results and Transfer Ownership
Sustaining is where the business case is either banked or lost. The value owner tracks KPIs for at least two quarters, while the transformation office checks that people keep working the new way.
Ownership then transfers to the line organization. Process owners take over the KPIs, data domains keep their stewards and the transformation office moves on to the next initiative in the portfolio.
Exit gate: KPIs are stable at target, and run costs and ownership sit in normal budgets.

How to Prioritize Initiatives: A Weighted Scoring Model
A scoring model gives every initiative the same test, so the loudest sponsor does not set the order. It also makes trade-offs visible when capacity runs short.
Score each initiative from 1 to 5 on five criteria, then multiply each score by its weight and add them up. For change load and risk, a higher score means a lighter load or a lower risk, so that every criterion points the same way.
Criterion Weight What a score of 5 looks like
Business value 30% Moves a top outcome target by a large, measurable amount
Dependency release 25% Several other initiatives are waiting on it
Data readiness 20% The data it needs is clean, owned and accessible
Change load 15% Few roles change, so adoption is simple
Risk 10% Low regulatory, delivery and operational risk
Adjust the weights to your strategy, but agree on them before anyone scores. Changing weights after the scores are in turns the model back into a negotiation.
Worked Example: Scoring Three Initiatives
The numbers in this example are illustrative. Imagine a manufacturer weighing three initiatives, an order-to-cash redesign, a customer master data cleanup and an AI demand-forecasting model.
Initiative Value (30%) Dependency (25%) Data readiness (20%) Change load (15%) Risk (10%) Weighted score
Order-to-cash redesign 5 4 3 2 3 3.70
Customer master data cleanup 3 5 4 4 4 3.95
AI demand forecasting 4 2 2 3 2 2.75
The data cleanup wins, even though it carries the lowest business value of the three. It scores highest because both other initiatives depend on clean customer data. For the cleanup, the sum is 3×0.30 + 5×0.25 + 4×0.20 + 4×0.15 + 4×0.10, which comes to 3.95.
Order to cash comes second and can start once the cleanup clears its first gate. The forecasting model ranks last in this first round, because weak data readiness would make its forecasts hard to trust. Rescore it after the data foundation lands, and it will probably climb.
How to Measure Enterprise Transformation: Cost, KPIs and ROI
Measurement keeps a roadmap honest. It answers three questions: what the program costs, which numbers should move and whether the return justifies the spend.
What Drives the Cost
Transformation budgets vary too widely for a useful average, so it helps to know what pushes them up. Five drivers explain most of the difference between two programs of similar size.
Scope: the number of functions, value streams and countries in the program.
Legacy debt: older systems need more custom integration and more careful retirement, so legacy system modernization often needs its own budget line.
Data remediation: cleaning, matching and governing master data takes longer than most plans allow.
Change load: every role that changes needs design, training and support time.
Parallel running: old and new systems run side by side during cutover, so you pay for both.
Budget each driver explicitly. A plan that funds technology but leaves data remediation and change load as contingency is understating its own cost.
A Simple ROI Formula
ROI compares the measured benefit with the full cost of getting it. Use the same period for both, and count a benefit only after it shows up against the baseline.
ROI = (measured benefit − total cost) ÷ total cost × 100
Here is an illustrative example. A value-stream program costs $2.0 million over three years, including run costs and parallel running. It then returns $3.2 million in measured savings and margin over the same three years. ROI is (3.2 − 2.0) ÷ 2.0 × 100, which gives 60%.
Include the time business people spend on the program in the total cost, because it is easy to leave out. Leaving it out flatters the ROI and, as a result, weakens your case at the next funding gate.
The KPI Scorecard
A scorecard balances four kinds of measures, so one good number cannot hide a bad one. Take every baseline before delivery starts, since a baseline taken afterwards cannot prove anything.
Category Example KPI What it tells you
Financial Cost-to-serve per order Whether the program is paying back
Operational Days to close, order cycle time Whether the work itself got faster
Adoption Share of transactions in the new process Whether people actually work the new way
Risk Open audit findings, control exceptions Whether speed came at the cost of control
Review the scorecard monthly at the portfolio meeting, using operational analytics rather than hand-built slides. A program that is green on financials but red on adoption is often about to give back its gains.

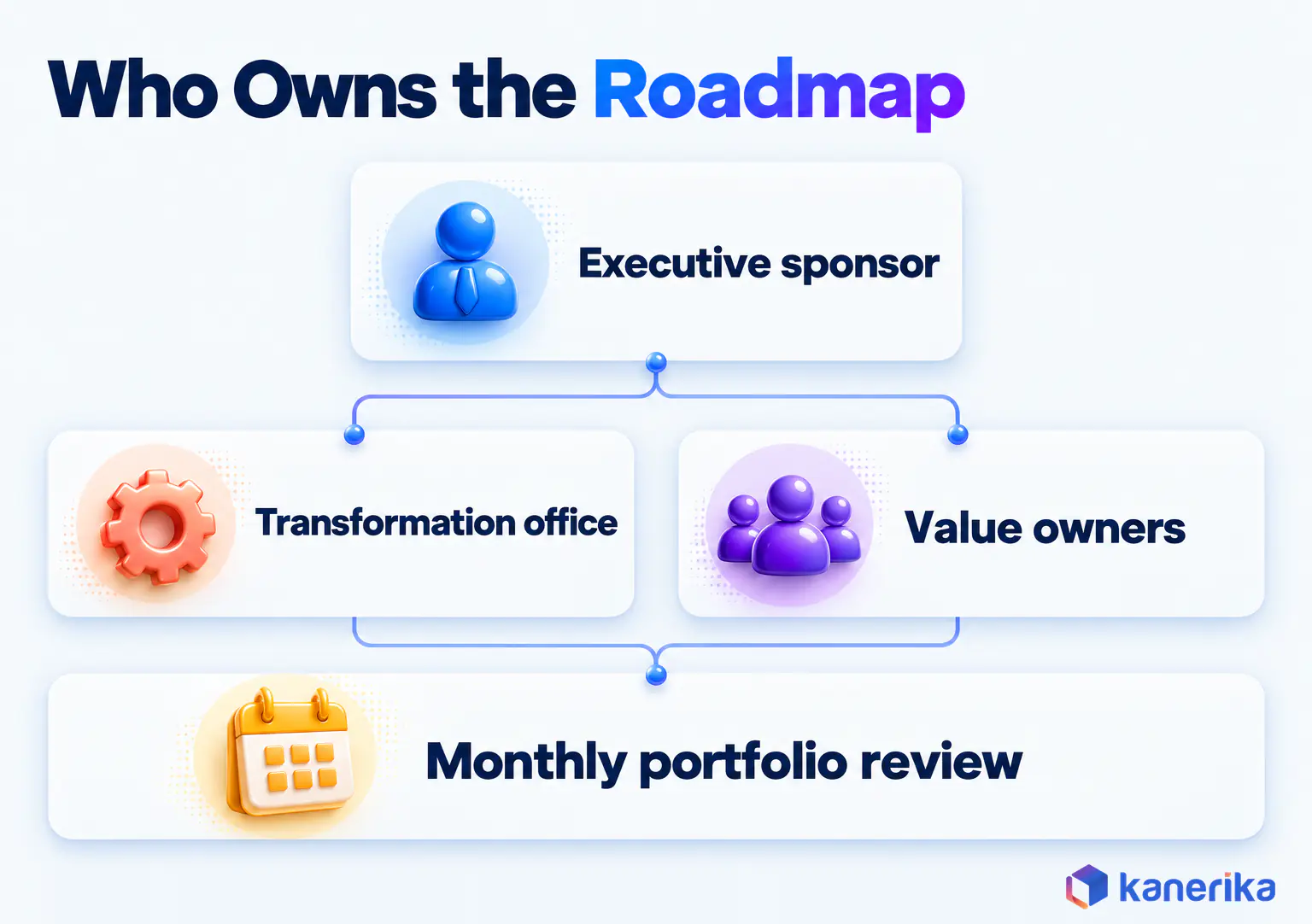

Governance: Who Owns the Roadmap
Every roadmap needs an owner with the authority to stop, start and resequence work. Without one, the mistakes above return as soon as the first deadline slips.
The Transformation Office and Its Cadence
A transformation office is a small team that runs the portfolio on behalf of the executive sponsor. It does not deliver the work itself. Instead, it keeps the plan, the dependency map, the scorecard and the gate reviews in one place.
Three roles and one meeting make the model work.
Executive sponsor: a CEO or COO-level leader who owns the outcome targets and settles cross-functional disputes.
Value owner per stream: a business leader who owns the stream’s KPIs and stays accountable after go-live.
Transformation office lead: runs the portfolio view, the gate reviews and the capacity plan.
Monthly portfolio review: the forum that checks KPIs, capacity and gates, then pauses work when capacity runs short.
Keep the cadence steady. A monthly review with the same scorecard builds trust faster than an occasional deep dive. It also surfaces problems while they are still small.
The Role of Enterprise Architecture
Enterprise architecture gives the roadmap a map of the territory. It records how capabilities, processes, data and systems connect at the start of the program, as well as what the target state should look like.
At Stage 2, the main artifact EA produces is a capability map. It lists each business capability, such as pricing or product data management, with the processes, data and systems behind it.
That map would have caught the pricing-engine clash from the dependency section on day one. The pricing engine sales wants in March sits on top of the product master, which is not scheduled until August. Architects can flag that gap before either plan is approved, rather than during integration testing.
Frameworks That Shape the Roadmap
External frameworks set requirements that the roadmap has to design for. Building them in early costs far less than retrofitting controls after go-live. Three come up in most programs: NIST CSF 2.0 , the NIST AI RMF and ISO/IEC 42001 .
Framework What it governs How it changes the roadmap
NIST Cybersecurity Framework 2.0 Cybersecurity risk, with a Govern function (added in version 2.0, February 2024) next to Identify, Protect, Detect, Respond and Recover Puts cyber risk ownership and policy into the design stage.
NIST AI RMF 1.0 and the Generative AI Profile (NIST-AI-600-1, July 26, 2024) Voluntary guidance for managing AI risk Adds risk mapping and monitoring to every AI initiative in the portfolio.
ISO/IEC 42001 An AI management system Treats AI governance as a standing system with owners and reviews.
Data controls matter just as much. The guide to data governance best practices covers them in detail. If AI initiatives sit in your portfolio, plan their risk reviews into every gate from Stage 2 onward.
Kanerika Service
AI Strategy and Roadmap
Kanerika helps you decide where AI fits in the portfolio, which data it needs first and how to govern it from design onward.
Explore AI Strategy
Where Data, Automation and AI Fit in the Roadmap
Data, automation and AI each have a place in the roadmap, and the order matters more than the tools. Getting the order wrong is an expensive way to waste an AI budget.
Start with a trusted data foundation. The shared domains from Stage 2 need owners, quality rules and one governed place to live. Our guide to data intelligence explains how that layer turns raw data into decisions people trust.
Next, automate the redesigned process. Automating the old process only makes a broken flow run faster. Once the new flow is agreed, enterprise workflow automation can carry work across systems and approvals without manual handoffs.
Then add AI on top of trusted data. A forecasting or document-reading model is only as reliable as the data and process around it. For use cases and patterns, see our guide to generative AI for business transformation .
The worked scoring example showed the same logic. The forecasting initiative ranked last because its data was not ready, while the data cleanup that would fix it ranked first.
Free White Paper
AI-Driven Business Transformation
Kanerika’s white paper for leaders deciding where AI belongs in a wider business transformation program.
Read the White Paper →
How Kanerika Helps Enterprises Turn Roadmaps Into Results
Kanerika helps enterprises build the data and AI foundations an enterprise transformation roadmap depends on, then prove value in short pilots before scaling. Our data strategy consulting work covers the assess and design stages. Our AI strategy and roadmap service then plans where AI fits once the data is ready.
The IMPACT Framework
IMPACT is the method Kanerika uses to run these engagements. The letters line up with the roadmap stages above roughly, not one to one, but clients can still see where every activity sits.
IMPACT step What it means Roadmap stage
I: Identify Find growth opportunities and hidden challenges Stage 1, Assess
M: Map Map strategic and actionable options Stage 2, Design
P: Prove Prove value through rapid, results-driven pilots Stage 3, Pilot
A: Analyze Analyze and show clear ROI The gate between Pilot and Scale
C: Create Create clear roadmaps with defined milestones Stage 4, Scale (the wave plan)
T: Transform Transform the business through agile execution Stages 4 and 5, Scale and Sustain
Case Study: A Food and Pharma Manufacturer’s Four-Week Proof of Value
A food and pharma manufacturer had its data spread across six business platforms, including NetSuite, RedZone, Parity Factory, UpKeep and Paychex. Reports were compiled by hand, so they were slow and hard to trust.
Kanerika ran a four-week proof of value on Microsoft Fabric . The team consolidated data from the six platforms into one governed bronze layer. Automated, secured ingestion then replaced manual report compilation, while a validation framework checked the data on the way in.
The pilot gave leadership proven feasibility and effort estimates before it committed to a full-scale build. That is Stage 3 working as intended, with a small, real proof that lowers the risk of the larger investment.
What to Look for in a Transformation Partner
Whichever partner you choose, test them against the same five questions. A shortlist of digital transformation companies in the USA is a useful starting point.
Do they start from your outcome targets and baselines, or from a technology?
Can they show a real pilot that moved a measured KPI?
Do they plan the data foundation and change load as funded work?
Will they hand over ownership, documentation and skills to your teams?
Do they build governance frameworks into design from the first stage?
A partner who answers these with evidence from past programs is worth a closer look. In particular, ask for the baseline and the result, and for who owned the KPI after go-live.
Talk to Kanerika
Turn Your Roadmap Into Measured Results
Talk to Kanerika about setting outcome baselines, or about running a short proof of value on one high-value process before you scale.
Talk to Our Team →
Final Verdict: What to Change in Your Roadmap This Quarter
A struggling roadmap can usually be repaired without starting over. Five changes made this quarter address the mistakes that stall most programs.
Rewrite each milestone as a business outcome with a baseline.
Map cross-functional dependencies, then resequence the backlog by them.
Fund the shared data foundation before the next wave of scaling.
Name a value owner for every stream who stays past go-live.
Put every program into one portfolio view with a monthly review.
Back at the manufacturer, the fix for the twelve-day close was an owner for the outcome, harmonized finance data and a baseline to measure against. Each of those comes from one of the five changes above.
All six mistakes that stall an enterprise transformation roadmap share one root: go-live is treated as the finish line. A gated roadmap fixes that by keeping an owner on the outcome until it shows up in the numbers.
Frequently Asked Questions
What does enterprise transformation mean?
Enterprise transformation means a coordinated change to how a whole organization operates, makes decisions and measures value. It moves strategy, operating model, processes, data and people together around shared outcomes, such as a faster order-to-cash cycle. Corporate transformation is often used for the same idea, though it sometimes refers to financial or structural restructuring led from the top.
What are the main elements of enterprise transformation?
The main elements are five dimensions that change together. Strategy sets the outcomes, the operating model sets decision rights and ownership, processes define the end-to-end flows, data and technology supply the platforms, and people bring the skills, roles and incentives. When one element lags, the others stall around it, so plan all five as one system.
How long does enterprise transformation take?
There is no fixed timeline, because duration depends on the approach. A targeted process fix can deliver in months, while a value-stream-led program usually runs for several quarters. An operating-model redesign takes multiple years and is delivered in waves. Short pilots of a few weeks help prove value before the longer commitment starts.
How much does enterprise transformation cost?
Costs vary too widely for a reliable average, so budget by driver instead. The main drivers are scope across functions and countries, legacy debt, data remediation, change load on affected roles and parallel running of old and new systems. Budget each one explicitly, and include the time business people spend on the program in the total.
How do you measure enterprise transformation success?
Use a balanced scorecard with financial, operational, adoption and risk measures, such as cost-to-serve, days to close, the share of transactions in the new process and open audit findings. Take every baseline before delivery starts. Then calculate ROI as measured benefit minus total cost, divided by total cost, over the same period.
Who should lead enterprise transformation?
An executive sponsor at CEO or COO level should own the outcome targets and settle cross-functional disputes. A small transformation office runs the portfolio, gate reviews and capacity plan. Each value stream also needs a business-side value owner who owns its KPIs and stays accountable for at least two quarters after go-live.
What role does enterprise architecture play in transformation?
Enterprise architecture maps how capabilities, processes, data and systems connect at the start of a program and what the target state should look like. That map lets the transformation office sequence initiatives by real dependencies and show which shared data or platforms an initiative needs first. It also stops sponsors from negotiating the order based on influence alone.
Where should enterprises start their transformation in 2026?
Start with outcomes and data. Name three to five measurable targets, take baselines and check the quality of the master data those outcomes depend on. Then pilot one high-value process end to end. With AI moving into core workflows, a trusted data foundation and early risk governance matter more in 2026 than before.
What is the best enterprise transformation framework?
No single framework fits every enterprise. A stage-gated roadmap of assess, design, pilot, scale and sustain works for most programs, combined with a weighted scoring model for priorities and a balanced KPI scorecard. Risk frameworks such as NIST CSF 2.0 and the NIST AI RMF then shape the design requirements inside that roadmap.
What are the principles of business transformation?
Start from measurable outcomes and take baselines before delivery. Sequence work by dependency, fund the shared data foundation early and prove value in a pilot before scaling. Treat change management as role and incentive design, keep one portfolio view across programs, and keep value owners accountable after go-live, because benefits arrive months after systems switch on.
What are the stages of enterprise transformation?
A practical roadmap has five stages. Assess sets outcome targets, baselines and readiness. Design defines the target operating model and sequences work by dependency. Pilot proves one high-value process end to end. Scale rolls the proven pattern out in waves. Sustain keeps KPIs on target and transfers ownership to the line organization, with an exit gate after every stage.
What are examples of business transformation?
Common examples include redesigning order to cash across sales, finance and logistics, consolidating finance onto one ledger after acquisitions, and moving support functions into shared services. A data example is a food and pharma manufacturer that consolidated six business platforms into one governed Microsoft Fabric layer during a four-week proof of value before committing to full scale.
What are the two key types of business transformation?
A common way to split it is incremental versus radical transformation. Incremental transformation improves existing processes and structures step by step, with lower risk and shorter cycles. Radical transformation redesigns the operating model or business model at once, which can create bigger gains but carries more delivery and change risk. Many enterprises combine both, piloting incrementally toward a radical target.
What are the 4 types of strategic change?
A widely used model names four types of strategic change. Adaptation is incremental change within the current paradigm. Reconstruction is rapid change that keeps the paradigm, such as a turnaround. Evolution is gradual change that shifts the paradigm over time. Revolution is fast, wide change to both structure and paradigm, often triggered by a crisis.
What is the difference between enterprise transformation and digital transformation?
Digital transformation changes technology, data and digital channels, usually led by the CIO or CDO and judged on adoption and platform performance. Enterprise transformation is broader. It changes the whole operating model across functions, including decision rights, processes and incentives, and it is judged on enterprise outcomes such as cost-to-serve, cycle time and growth.
Why do enterprise transformation initiatives fail?
Initiatives usually stall for planning reasons more than technical ones. Roadmaps track go-live dates instead of business outcomes, leave cross-functional dependencies unmapped and push the data foundation to a later phase. Change management shrinks to training, accountability ends at go-live and too many programs compete for the same experts without a single portfolio view.
How do you create an enterprise transformation roadmap?
Begin with three to five measurable outcome targets and baseline each one. Assess data, people and technology readiness, then design the target operating model and map dependencies. Score initiatives with a weighted model, pilot one high-value process end to end, scale in waves and sustain results with named value owners. Add an exit gate after every stage.
